施工临时用电方案计算书
- 格式:doc
- 大小:136.50 KB
- 文档页数:19
2、确定用电负荷:(1)、混凝土输送泵Kx = 0.3 Cosφ = 0.7 tgφ = 1.02 Pjs= 0.3×75 = 22.5 kWQ js = Pjs× tgφ=22.5×1.02 = 22.95 kvar(2)、强制式混凝土搅拌机Kx = 0.75 Cosφ = 0.85 tgφ = 0.62 Pjs= 0.75×60 = 45 kWQ js = Pjs× tgφ=45×0.62 = 27.89 kvar(3)、配料机Kx = 0.7 Cosφ = 0.3 tgφ = 3.18 Pjs= 0.7×0.3 = 0.21 kWQ js = Pjs× tgφ=0.21×3.18 = 0.67 kvar(4)、平板式振动器Kx = 0.3 Cosφ = 0.7 tgφ = 1.02 Pjs= 0.3×2.2 = 0.66 kWQ js = Pjs× tgφ=0.66×1.02 = 0.67 kvar(5)、插入式振动器Kx = 0.3 Cosφ = 0.7 tgφ = 1.02 Pjs= 0.3×1.6 = 0.48 kWQ js = Pjs× tgφ=0.48×1.02 = 0.49 kvar(6)、插入式振动器Kx = 0.3 Cosφ = 0.7 tgφ = 1.02 Pjs= 0.3×0.8 = 0.24 kWQ js = Pjs× tgφ=0.24×1.02 = 0.24 kvar(7)、交流电焊机Kx = 0.35 Cosφ = 0.4 tgφ = 2.29将J c =50%统一换算到J c1 =100%的额定容量P n = Sn×Cosφ= 76×0.4=30.4kWP e = n×(Jc/Jc1)1/2×Pn = 1×(0.5/1)1/2×30.4 = 21.5 kWP js = Kx×Pe=0.35×21.5 = 7.52kWQ js = Pjs× tgφ=7.52×2.29 = 17.24 kvar(8)、备用Kx = 0.7 Cosφ = 0.7 tgφ = 1.02 Pjs= 0.7×20 = 14 kWQ js = Pjs× tgφ=14×1.02 = 14.28 kvar(9)总的计算负荷计算,总箱同期系数取 Kx = 0.9 总的有功功率P js = Kx×ΣPjs= 0.9×(22.5+45+0.21+0.66+0.48+0.24+7.52+14) = 81.553kW总的无功功率Q js = Kx×ΣQjs=0.9×(22.95+27.89+0.67+0.67+0.49+0.24+17.24+14.28)= 75.996 kvar总的视在功率S js = ( Pjs2+Qjs2)1/2 = (81.5532+75.9962)1/2 = 111.473 kVA总的计算电流计算I js = Sjs/(1.732×Ue) = 111.473/(1.732×0.38) = 169.371 A3、1号干线线路上导线截面及分配箱、开关箱内电气设备选择:在选择前应对照平面图和系统图先由用电设备至开关箱计算,再由开关箱至分配箱计算,选择导线及开关设备。
施工现场临时用电计算书计算书1、总用电量计算(依据公式) :(1) P1①井塔吊和木工设备K x = 0.5 , Cos© = 0.7 ;P js =44.4KW木工机具:7.5 KW44.4+7.5=51.9 KW(2) P2供搅拌机、砂浆机和A楼施工用电K x = 0.5 ,Cos© = 0.7 ;P js =10.5KWA楼照明=50 KW10.5+50=60.5 KW(3) P3 两台人货电梯用电K x = 0.5 ,Cos© = 0.7 ;P js =20kW(4) P4 B 楼施工用电K x = 0.5 ,Cos© = 0.7 ;P js = 50kW(5) P5②#塔吊K x = 0.5 ,Cos© = 0.7 ;P js = 44.4kW(6) P6 钢筋切断、对焊、调直和弯曲等机组K x = 0.5 , Cos© = 0.7 ;P js = 89.93kW(7) 总的负荷计算,功率因数= 0.7 ,系数取=0.5。
总的有功功率P js= (51.9 +60.5 +20+50+44.4+89.93+A、B 楼照明和移动机具225.1) = 541.83kW计算变压器容量= K x 541/0.7=386kVAljs=0.5X 541KW/1.732X 0.38 X 0.7=588A2、选择变压器根据计算的总的容量选择ZBW-450/10 型三相电力变压器,它的容量为450kVA>386kVA X 1.1(增容系数)能够满足使用要求,其高压侧电压为10kV 同施工现场外的高压架空线路的电压级别一致。
3、选择总箱的进线截面及进线开关(1) 选择导线截面:上面已经计算出总计算电流l js = 588A ,查表得室外埋设线路40° C时选择240伽2,其安全载流量为592A,能够满足使用要求。
由于供电箱至动力总箱距离短,可不校核电压降的选择。
桥梁工程临时用电方案计算书一、项目背景及用电需求这座桥梁工程跨越了一条繁忙的河流,工程规模宏大,施工周期紧张。
为确保工程顺利进行,临时用电的需求尤为重要。
经过初步估算,施工现场需要供电的设备包括:照明、焊接、切割、泵送、搅拌等,总功率约为2000千瓦。
二、临时用电系统设计1.供电方式根据施工现场的位置和周围供电条件,我们决定采用三相四线制供电方式。
这种方式既满足了现场设备的功率需求,又能保证供电的稳定性和安全性。
2.供电线路供电线路采用电缆敷设,从附近的变电站引出一路10千伏高压线,经过变压器降压至380伏,再通过电缆引至施工现场。
电缆敷设过程中,要保证电缆的埋深和固定,防止因外力损坏导致停电事故。
3.配电箱配电箱是临时用电系统的核心部分,负责分配和控制现场设备的供电。
配电箱内设有总闸、分闸、漏电保护器等设备,确保用电安全。
配电箱的安装位置要便于操作和维护,同时要考虑到现场环境的特殊性,如防雨、防晒等。
4.设备接线设备接线是临时用电系统的一环,也是最容易出现问题的地方。
在接线过程中,要严格按照设备说明书和施工规范进行操作,确保接线正确、牢固。
同时,要定期检查设备接线,防止因接线不良导致设备损坏。
三、安全措施1.检查与维护临时用电系统在投入使用前,要进行全面的检查,确保设备完好、接线正确。
在使用过程中,要定期进行维护,发现问题及时处理。
2.防雷与接地桥梁工程位于雷暴频繁的地区,防雷工作尤为重要。
施工现场的临时用电系统要安装防雷装置,同时做好接地处理,降低雷击事故的风险。
3.安全培训加强对现场施工人员的安全培训,提高他们的安全意识。
培训内容包括:临时用电安全知识、设备操作规程、紧急事故处理等。
四、成本分析1.设备投资临时用电系统所需的设备投资包括:变压器、电缆、配电箱、设备等。
这些设备的投资成本约为50万元。
2.运营成本运营成本主要包括:电费、维护费、人工费等。
根据施工现场的用电需求,预计年电费约为100万元,维护费和人工费约为20万元。
施工现场临时用电专项方案的计算书和验算依据1.临时用电计算用电验算依据:根据公式(1)计算出导线上的允许电流,查表可得满足电流要求的配电导线截面积,根据公式(2)计算满足要求的导线电压降所需最小截面积,取两者之间的大值作为配电导线的截面积。
1)按导线允许电流选择三相五线制低压线路上的电流可按下式计算ϕCOS U PI ⨯⨯=1131000(1)式中:l I —线路工作电流值(A )。
l U —线路工作电压值(V ),三相五线制低压时,380l U V =。
P —计算用电量(kVA )。
cos ϕ—用电设备功率因数,取0.7。
2)按允许电压降校核三相五线制低压线路导线截面积可按下式计算 max min ε⨯⨯=∑C LP S (2)式中:min S —导线截面积(mm 2)。
L —变压器低压开关据现场距离(m ),取100L m =。
C —材料内部系数,根据电压和电流种类取用,取46.3C =。
max ε—导线电压降(%),一般工地临时用电网络取7。
P —计算用电量(kVA )。
根据公式(1)及公式(2)计算配电线路截面面积,计算过程如下:(1)1#拌和站 按导线允许电流计算:A I l 1.4317.038036.1981000=⨯⨯⨯= 按允许电压降计算: 2min 3.6173.461006.198mm S =⨯⨯= (2)xxx 大桥、1#钢筋场地按导线允许电流计算:A I l 6.6717.038034.3091000=⨯⨯⨯= 按允许电压降计算: 2min 5.9573.461004.309mm S =⨯⨯= (3)xxx 、预制梁场、2#钢筋加工厂及2#拌和站 按导线允许电流计算:A I l 8.9307.038038.4281000=⨯⨯⨯= 按允许电压降计算: 2min 132.373.461008.428mm S =⨯⨯= (4)xxx 大桥 按导线允许电流计算:A I l 2.4577.038036.2101000=⨯⨯⨯= 按允许电压降计算: 2min 0.6573.461006.210mm S =⨯⨯= (5)xxx 隧道按导线允许电流计算:A I l 2.17747.038034.8171000=⨯⨯⨯= 按允许电压降计算: 2min 2.25273.461004.817mm S =⨯⨯= (6)xxx 大桥、3#拌和站及2#钢筋加工厂按导线允许电流计算:A I l 6.8237.038034.3791000=⨯⨯⨯= 按允许电压降计算: 2min 1.11773.461004.379mm S =⨯⨯= (7)xxx 隧道按导线允许电流计算:A I l 2.16227.038034.7471000=⨯⨯⨯= 按允许电压降计算: 2min 6.23073.461004.747mm S =⨯⨯= (8)xxx 大桥按导线允许电流计算:A I l 3.3217.038030.1481000=⨯⨯⨯= 按允许电压降计算: 2min 7.4573.4610001.148mm S =⨯⨯=。
施工临时用电方案计算书1. 引言在工程施工过程中,临时用电是必不可少的一项工作。
临时用电方案的合理设计对保障施工工作的正常进行具有重要作用。
本文将针对施工临时用电方案进行计算和设计,以保证施工过程中的用电需求得到满足。
2. 计算方法临时用电方案的计算需要考虑以下几个方面:•施工现场的总用电负荷:–施工机械设备的用电负荷;–临时仓库、办公区等临时设施的用电负荷;–施工现场照明和通风设备的用电负荷;–其他特殊设备的用电负荷。
•用电功率的计算:–根据施工机械设备的参数,计算每台机械设备的用电功率;–根据临时设施的规模和使用情况,计算临时设施的用电功率;–根据照明和通风设备的数量和规格,计算照明和通风设备的用电功率;–根据特殊设备的参数,计算特殊设备的用电功率。
•用电容量的确定:–根据施工现场的总用电负荷和用电功率计算得出施工现场的总用电容量;–考虑到施工中可能出现的临时用电负荷增加的情况,应在总用电容量的基础上增加一定的安全裕度。
3. 临时用电方案计算示例下面是一个临时用电方案计算的示例,以便更好地理解计算方法。
3.1 某施工现场的信息:•施工机械设备:起重机1台(功率20kW),挖掘机2台(每台功率15kW),压路机1台(功率10kW);•临时设施:办公区(功率5kW),临时仓库(功率3kW);•照明和通风设备:50个照明灯(每个功率100W),3个通风设备(每个功率200W);•特殊设备:电焊机(功率8kW),空压机(功率6kW)。
3.2 用电功率的计算:施工机械设备的用电功率: - 起重机:20kW; - 挖掘机:2台 × 15kW/台 = 30kW; - 压路机:10kW。
临时设施的用电功率: - 办公区:5kW; - 临时仓库:3kW。
照明和通风设备的用电功率: - 照明灯:50个 × 100W/个 = 5000W; - 通风设备:3个 × 200W/个 = 600W。
临时用电计算书一、地下通道用电设备统计用电设备如下表所示:计划采用两台500kv的电压器供电。
二、用电设备用电距离根据变压器布置位置及施工区段长度,施工时,用电设备最大用电距离为100米,且主要用电负荷在中间通道三轴搅拌桩施工及地连墙施工节段。
三、变压器容量计算施工段最大用电量为936.8kw ,按所有机械运转满负荷计算变压器容量。
根据《建筑施工计算手册》、《施工现场临时用电安全技术规范》JGJ 46-2005计算。
3.1 表1-1 3.1.1 用电量计算: 计算公式如下:111.1(0.1) 1.24C C P K P P K P =+=∑∑其中 P ── 计算用电量(kW),即供电设备总需要容量; K1 ── 全部施工用电设备同时使用系数;总数10台以内取0.75;10-30台取0.7;30台以上取0.6;K3 ── 照明设备同时使用系数,取1.0; 本例计算中K1=0.7;经过计算得到 P =1.24×K1×∑pc=1.24×0.7×936.8=813.14kVA 。
3.1.2 变压器容量选择:根据以上的施工机械用电负荷,进行变压器容量计算:变压器容量计算公式如下:01.05P P其中P0 ──变压器容量(kVA);1.05 ──功率损失系数;经过计算得到P0 =1.05×p=1.05×813.14=853.8kVA<1000(KVA)两台变压器。
综上,采用两台500KVA的变压器即可满足施工要求。
四、电缆及空气开关的选用4.1施工电缆、空开的选用4.1.1三轴搅拌桩机二级配电电缆选用全部施工动力用电设备额定用量:经过计算得到P =1.24×K1×∑pc=1.24×0.75×494=459.42kW。
计算公式如下:其中P ──计算用电量(kW),即供电设备总需要容量;Pc ──全部施工动力用电设备额定用量之和;Pa ──室内照明设备额定用电量之和;Pb ──室外照明设备额定用电量之和;K1 ──全部施工用电设备同时使用系数;总数10台以内取0.75;10-30台取0.7;30台以上取0.6;K2 ──室内照明设备同时使用系数,取0.8;K3 ──室外照明设备同时使用系数,取1.0;综合考虑施工用电约占总用电量90%,室内外照明电约占总用电量10%,则有:本例计算中K1=0.75;P=1.24×0.75×494=459.42kW根据以上的施工机械用电负荷及电传输距离,进行总导线的截面计算:1.按导线的允许电流选择:三相四线制低压线路上的电流可以按照下式计算:(规范规定需要三相四线制配电的电缆线路必须采用五芯电缆):其中Il ──线路工作电流值(A);Ul ──线路工作电压值(V),三相四线制低压时取380V。
施工临时用电计算书检查施工单位是否按如下公式进行验算,以满足施工现场用电量及安全生产需要。
4.1.用电量计算:依下公式进行P=1.05~1.1(K1ΣP1/cosφ+K2ΣP2+ K3ΣP3+ K4ΣP4)式中:P—供电设备总需安装量(KVA)P1——电动机额定功率(KW)P2——电焊机额定容量(KVA)P3——室内照明容量P4——室外照明容量cosφ—电动机平均功率因数(施工现场最高0.75—0.78,一般为0.65—0.75)4.2.导线截面选择的理论和公式:a、按机械强度选择:导线必须保证不致因一般机械损伤折断。
b、按容许电流选择:导线必须承受负载电流长时间通过引起的升温。
c、导线电压降必须在一定限度内。
所选用导线截面必须同时满足以上三项要求。
在建筑工地配电线路较短,导线截面可由容许电流选定,计算公式如下:a、按最小机械强度选择导线截面:架空BX=10㎜2,BLX=16㎜2(BX为外护套橡皮线、BLX为橡皮铝线)b、按安全载流量选择导线截面:Ijs =KX*Σ(Pis)/3*Uecosφ式中:Ijs —计算电流、KX—同时系数(取0.7—0.8)、Pis—有功功率Ue—线电压、cosφ—功率因数c、按容许电压降选择导线截面:S= KX *Σ(Pe*L)/Ccu*△U式中:S—导线截面、Pe —额定功率、Pis—负载到配电箱的长度Ccu—常数(三相四项制77、单项12.8)△U—允许电压降、临时用电用8%、正式电路取10%4.3.配电箱布置,着重监督施工单位做好以下工作,使施工用电趋于规范化和专业化:4.3.1.金属箱架、门、安装板不带电的金属外壳及靠近带电部分的金属护栏等均需采用绿黄双色多股软绝缘导线与PE保护零线做可靠连接。
施工现场临时用电的配置:以“三级配电、三级漏保”,“一机一闸一漏一箱一锁”为原则。
4.3.2.漏电开关的漏电动作电流分级设置:A级配电箱:I△n <100mA T△n<0.1SB级配电箱:I△n <50mA T△n<0.1SC级配电箱:I△n <30mA T△n<0.1S手持电动工具、夯土电动机械、潮湿场所等活动箱内须采用I△n<15mAT△n<0.1S 的漏电保护开关。
施工临时用电方案计算书一、编制依据《低压配电设计规范》GB50054-95中国建筑工业出版社《建筑工程施工现场供电安全规范》GB50194-93中国建筑工业出版社《通用用电设备配电设计规范》GB50055-93中国建筑工业出版社《供配电系统设计规范》GB50052-95中国建筑工业出版社《施工现场临时用电安全技术规范》JGJ46-2005中国建筑工业出版社《建筑施工安全检查标准》JGJ59-99二、施工条件施工现场用电量统计表:----------------------------------------------------------------------序号机具名称型号安装功率(kW) 数量合计功率(kW)1 平板式振动器 ZB11 1.1 11.12 混凝土输送泵 HB-15 32.2 132.23 卷扬机 JJM-0.5 3 3 94 插入式振动器 ZX50 1.1 55.55 灰浆搅拌机 UJ100 2.2 36.66 蛙式夯土机 HW-32 1.5 34.57 钢筋切断机 QJ32-1 3 1 38 钢筋调直机 GT4/14 4 1 49 木工圆锯 MJ104 3 3 910 木工平刨床 MB503A 3 3 911 钢筋弯曲机 GW40 3 1 312 直流电焊机 AX1-165(AB-165) 6 2 1213 交流电焊机 BX3-120-1 9 2 1814 白炽灯 1 3 315 高压汞灯 3 20 6016 荧光灯 0.2 20 417 塔式起重机 TQ90(自升式) 58 1 5818 塔式起重机 TQ90(自升式) 58 1 58----------------------------------------------------------------------三、设计内容和步骤1、现场勘探及初步设计:(1)本工程所在施工现场范围内施工前无各种埋地管线。
(2)现场采用380V低压供电,设一配电总箱,内有计量设备,采用TN-S系统供电。
****三期工程临时用电方案及计算书上海****工程有限公司二〇二〇年六月****三期临时用电方案及计算书上海****工程有限公司目录第一章工程概况 (1)第二章编制依据 (1)第三章工程说明 (2)第四章施工现场用电量计算 (3)一、主要施工用电一览表 (3)二、线路布置 (5)三、配电导线截面选择 (6)第五章总配电箱及箱内开关电器的选择 (10)第六章各开关箱内开关电器的选择 (11)第七章接零、接地设计 (17)第八章防雷设计 (18)第九章安全用电技术措施 (18)第十章电气防火措施 (19)第十一章绿色节能措施 (20)第十二章临时用电布置 (21)第十三章施工安全管理措施及绿色施工 (21)第十四章安全技术档案 (23)第十五章应急救援 (23)第十六章有关附件 (24)第一章工程概况工程名称: 上海市奉贤区****项目三期工程建设地点:奉贤区金汇镇大叶公路6288弄建设单位: 上海****有限公司设计单位: 上海****设计有限公司监理单位: 上海****项目管理咨询有限公司勘察单位: 上海****勘察有限公司施工单位:上海****工程有限公司质量目标:合格安全目标:杜绝重大伤亡事故发生,安全生产重大事故为零,一般事故率控制在1.5‰以内,无重大火灾事故、无刑事案件发生、无重大设备、管线、交通施工,达到上海市奉贤区施工现场安全质量标准化优良等级。
本工程为上海****有限公司开发的上海市****三期项目,由上海****工程有限公司承揽施工建造,位于奉贤区金汇镇大叶公路6288弄。
三期总建筑面积131284.83平方米。
其中地上建筑面积59168.16平方米,地下建筑面积72116.67平方米(住宅地下室面积31106.76平米;地下车库面积41009.91平米)。
三期工程主要由76幢3层联排住宅楼(框架结构)组成,设地下室一层,底板深度约为±0.00m以下5.9m,最大建筑高度为12.8m。

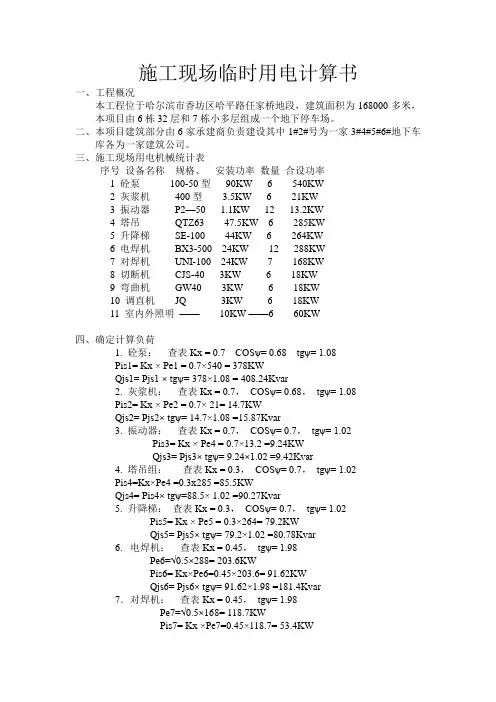

施工现场临时用电计算书一、工程概况本工程位于哈尔滨市香坊区哈平路任家桥地段,建筑面积为168000多米,本项目由6栋32层和7栋小多层组成一个地下停车场。
二、本项目建筑部分由6家承建商负责建设其中1#2#号为一家3#4#5#6#地下车库各为一家建筑公司。
三、施工现场用电机械统计表序号设备名称规格、安装功率数量合设功率1 砼泵100-50型90KW 6 540KW2 灰浆机400型 3.5KW 6 21KW3 振动器P2—50 1.1KW 12 13.2KW4 塔吊QTZ63 47.5KW 6 285KW5 升降梯SE-100 44KW6 264KW6 电焊机BX3-500 24KW 12 288KW7 对焊机UNI-100 24KW 7 168KW8 切断机CJS-40 3KW 6 18KW9 弯曲机GW40 3KW 6 18KW10 调直机JQ 3KW 6 18KW11 室内外照明——10KW ——6 60KW四、确定计算负荷1. 砼泵:查表Kx = 0.7 COSψ= 0.68tgψ= 1.08Pis1= Kx × Pe1 = 0.7×540 = 378KWQjs1= Pjs1 × tgψ= 378×1.08 = 408.24Kvar2. 灰浆机:查表Kx = 0.7,COSψ= 0.68,tgψ= 1.08Pis2= Kx × Pe2 = 0.7× 21= 14.7KWQjs2= Pjs2× tgψ= 14.7×1.08 =15.87Kvar3. 振动器:查表Kx = 0.7,COSψ= 0.7,tgψ= 1.02Pis3= Kx × Pe4 = 0.7×13.2 =9.24KWQjs3= Pjs3× tgψ= 9.24×1.02 =9.42Kvar4. 塔吊组:查表Kx = 0.3,COSψ= 0.7,tgψ= 1.02Pis4=Kx×Pe4 =0.3x285 =85.5KWQjs4= Pis4× tgψ=88.5× 1.02 =90.27Kvar5. 升降梯:查表Kx = 0.3,COSψ= 0.7,tgψ= 1.02Pis5= Kx × Pe5 = 0.3×264= 79.2KWQjs5= Pjs5× tgψ= 79.2×1.02 =80.78Kvar6. 电焊机:查表Kx = 0.45,tgψ= 1.98Pe6=√0.5×288= 203.6KWPis6= Kx×Pe6=0.45×203.6= 91.62KWQjs6= Pjs6× tgψ= 91.62×1.98 =181.4Kvar7.对焊机:查表Kx = 0.45,tgψ= 1.98Pe7=√0.5×168= 118.7KWPis7= Kx ×Pe7=0.45×118.7= 53.4KWQjs7= Pjs7×tgψ= 53.4× 1.98 =105.7Kvar8. 切断机:查表Kx = 0.7,tgψ= 1.02Pis8= Kx × Pe8= 0.7×18=12.6KWQjs8= Pjs9×tgψ= 12.6×1.02 =12.85Kvar9. 弯曲机:查表Kx = 0.7,tgψ= 0.88Pis9= Kx×Pe9=0.7×18=12.6KWQjs9= Pjs9×tgψ= 12.6×0.88 =11.08Kvar10.调直机:查表Kx = 0.7,tgψ= 0.88Pis10= Kx×Pe10=0.7×18=12.6KWQjs10= Pjs10×tgψ= 12.6×0.88 =11.08Kvar11. 总的计算负荷计算,干线同期系数取KX=0.9Pis=KX ×(Pis1+ Pis2…+ Pis10)=0.9×749.46=674.5KW总的无功功率:Qis= KX ×(Qis1+ Qis2…+ Qis9)=0.9×926.69=834.02KW总的视在功率:Sis =√Pis2+Qis2=√204.22+342.362=1072.63KV A总的计算电流计算:Iis = Sis/(√3•Ue)=1072.63/(√3×0.38 )=1629.69A315KV A湿式变压器超载率20%(根据标牌估算)计算:张跃辉办公楼照明电气中,已知本用电系统各功率的总和Pe,另外通过表查得需要系数值Kx,功率因素值cos∮,想计算出Ijs值,请问公式是怎样的?Ijs=Pe*Kx/1.732*0.38*cos∮.配电手册中的负荷计算章节都有这计算公式.三相电流计算:Ijs=Pe*Kx/1.732*0.38*cos∮.单相电流计算:Ijs=Pe*Kx/*0.22*cos∮.再重复一次吧:配电设计手册中的负荷计算章节都有这计算公式.。
XXXXX工程部施工现场临时用电方案______________________________审批:_______________时间:年月日中建四局第三建筑工程目录一、施工现场用电情况 (2)二、工程概况及现场勘测 (4)三、编制依据 (4)四、施工现场用电设备及照明 (5)五、现场用电布置 (5)六、施工现场临时用电负荷计算书 (5)七、安装技术要求 (8)八、防雷装置设计 (10)九、平安用电技术措施 (10)十、电气防火措施 (11)十一、电工岗位职责 (12)十二、配电房电工操作规程 (12)十三、平安技术档案 (12)十四、事故应急预案 (13)十五、现场设备线路图 (15)十六、总配电房线路接线示意图 (16)十七、漏电保护器使用接线示意图 (17)十八、TN-S接零保护系统示意图 (18)十九、二级分配电箱安装示意图 (19)二十、三级开关箱安装示意图 (20)二十一、施工现场用电系统图 (22)二十二、楼层用电立面示意图 (23)二十三、楼层用电负荷计算 (24)一、施工现场用电情况二、工程概况及现场勘测贵阳十里花川—G区工程临近于水东路旁,由中天城投集团贵阳房地产开发兴建,中建四局第三建筑工程承建,贵州三维工程建设监理咨询监督施工工程,本工程主要结构形式为钢筋砼+钢结构,建筑面积约为896701m2。
为指导施工现场临时用水、用电的使用,编制该方案,结合本工程施工现场的地理环境和特点,施工临时用水主要考虑施工现场生产用水、生活用水和消防用水三类,并作为临时用水设计计算书的重要局部;供电平面布置电源进线由业主提供的配电房引出,每台变压器容量为630KVA供电,考虑到电压降低等综合因素后,采用规格为185mm2铝芯线从甲方配电房接出,按标准要求架空〔或埋设〕敷设至现场配电箱400A开关。
供电线路按工地实际用电量、用电地点设置〔按标准埋设或架空〕,其它施工机械设备、照明用电、楼层用电等,以现场实际布置为准〔详见供电平面布置图〕。
道路施工现场临时用电方案计算书1.1计算依据1.《建设工程施工现场供用电安全规范》GB50194-932.《施工现场临时用电安全技术规范》JGJ46-20053.《低压配电设计规范》GB50054-954.《供配电系统设计规范》GB50052-955.《通用用电设备配电设计规范》GB50055-936.《建筑施工安全检查标准》JGJ59-20111.2现场勘探及初步设计1.本工程所在施工现场范围内部分地区有埋地管线,在搭接线路时严格保护原有管线不被破坏。
2.现场采用380V低压供电,设8配电总箱,内有计量设备,采用TN-S系统供电。
3.根据施工现场用电设备布置情况,采用导线架空敷设,布置位置参见现场平面图,采用三级配电,两极防护。
4.按照《JGJ46-2005》规定制定施工组织设计,接地电阻R≤4Ω1.3一号取电点用电计算位置:项目部门口右侧、明渠边上,主要供项目部生活用电及桥梁桩基施工用电。
1.3.1项目部及桥梁桩基主要用电量统计表1.3.2项目部及桥梁桩基用电量计算(1)、钢筋切断机K x=0.65,Cosφ=0.8,tgφ=0.75P js=0.65×2×1.5=7.15kWQ js=P js×tgφ=7.15×0.75=1.3625kvar (2)、钢筋切断机K x=0.65,Cosφ=0.8,tgφ=0.75P js=0.65×2×7.5=9.75kWQ js=P js×tgφ=9.75×0.75=7.3125kvar(3)、钢筋箍筋弯曲机K x=0.8,Cosφ=0.85,tgφ=0.62P js=0.8×2×1.5=2.4kWQ js=P js×tgφ=2.4×0.62=1.488kvar(4)、钢筋弯曲机K x=0.65,Cosφ=0.8,tgφ=0.75P js=0.65×2×3=3.9kWQ js=P js×tgφ=3.9×0.75=2.925kvar(5)、钢筋调直切断机K x=0.65,Cosφ=0.8,tgφ=0.75P js=0.65×2×4=1.2kWQ js=P js×tgφ=1.2×0.75=3.9kvar(6)、对焊机K x=0.65,Cosφ=0.8,tgφ=0.75将J c=20%统一换算到J c1 =100%的额定容量P n=16kWP e=n×(J c/J c1)1/2×P n=2×(0.2/1)1/2×16=14.31 kW P js=K x×P e=0.65×3×14.31=27.9045kWQ js=P js×tgφ=27.9045×0.75=20.93kvar(7)、碘钨灯K x=0.65,Cosφ=0.8,tgφ=0.75P js=0.65×1×35=22.75kWQ js=P js×tgφ=22.75×0.75=17.1kvar(8)、钢筋直螺纹套丝机K x=0.65,Cosφ=0.8,tgφ=0.75P js=0.65×3×4=7.8kWQ js=P js×tgφ=7.8×0.75=1.85kvar(9)、管理人员办公室节能灯K x=0.8,Cosφ=0.7,tgφ=1.02将J c=60%统一换算到J c1 =70%的额定容量 P n=0.1kWP e=n×(J c/J c1)1/2×P n=150×(0.6/0.7)1/2×0.1=13.125kWP js=K x×P e=0.8×13.125=10.5kWQ js=P js×tgφ=10.5×1.02=10.71kvar(10)、插入式振动器K x=0.65,Cosφ=0.9,tgφ=0.48P js=0.65×1.1×2=1.43kWQ js=P js×tgφ=1.43×0.48=0.69kvar (11)、潜水泵K x=0.65,Cosφ=0.9,tgφ=0.48P js=0.65×2.2×20=28.6kWQ js=P js×tgφ=28.6×0.48=13.728kvar(12)、搅拌机K x=0.7,Cosφ=0.9,tgφ=0.48P js=0.7×7.5×2=10.5kWQ js=P js×tgφ=10.5×0.48=1.04kvar(13)卷扬机K x=0.7,Cosφ=0.9,tgφ=0.48P js=0.7×1.5×20=21kWQ js=P js×tgφ=21×0.48=10.08kvar(14)、手提电钻K x=0.7,Cosφ=0.9,tgφ=0.48将J c=40%统一换算到J c1 =100%的额定容量 P n=1.5kWP e=n×(J c/J c1)1/2×P n =15×(0.4/1)1/2×1.5=14.25kW P js=K x×P e=0.7×14.25=9.975kWQ js=P js×tgφ=9.975×0.48=4.788kvar(15)、管理人员宿舍照明节能灯K x=0.7,Cosφ=0.9,tgφ=0.48将J c=60%统一换算到J c1 =70%的额定容量P n=0.04kWP e=n×(J c/J c1)1/2×P n =100×(0.6/0.7)1/2×0.1=3.8 kWP js=K x×P e=0.7×3.8=2.66kWQ js=P js×tgφ=2.66×0.48=1.2768kvar(16)、管理人员办公室空调及电脑K x=0.7,Cosφ=0.9,tgφ=0.48将J c=60%统一换算到J c1 =70%的额定容量P n=2.3kWP e=n×(J c/J c1)1/2×P n =45×(0.6/0.7)1/2×2.3=39.33 kWP js=K x×P e=0.7×39.33=27.531kWQ js=P js×tgφ=27.531×0.48=13.215kvar(17)、管理人员办公室打印机K x=0.7,Cosφ=0.9,tgφ=0.48将J c=60%统一换算到J c1 =70%的额定容量P n=0.02kWP e=n×(J c/J c1)1/2×P n=20×(0.6/0.7)1/2×0.02=0.152 kWP js=K x×P e=0.7×0.152=0.1064kWQ js=P js×tgφ=0.1064×0.48=0.0511kvar(18)、厨房排气扇K x=0.65,Cosφ=0.8,tgφ=0.75P js=0.65×0.1×1=0.065kWQ js=P js×tgφ=0.065×0.75=0.04875kvar(19)、蒸饭机K x=0.65,Cosφ=0.8,tgφ=0.75P js=0.65×6×1=3.9kWQ js=P js×tgφ=3.9×0.75=2.925kvar(20)、室外照明K x=0.8,Cosφ=0.7,tgφ=1.02将J c=60%统一换算到J c1 =70%的额定容量P n=0.024kWP e=n×(J c/J c1)1/2×P n=30×(0.6/0.7)1/2×0.024=0.63kWP js=K x×P e=0.8×0.63=0.504kWQ js=P js×tgφ=0.504×1.02=0.515kvar一号取电点:总的负荷计算,总箱同期系数取Kx=0.85总的有功功率:P js=K x×ΣP js=0.85×(7.15+9.75+2.4+3.9+1.2+27.9045+ 22.75+7.8+10.5+1.43+28.6+10.5+21+9.975+2.66+27.531+ 0.1064+0.065+3.9+0.504)=203.6259kW总的无功功率:Q js=K x×ΣQ js=0.85×(1.3625+7.3125+1.488+2.925+3.9+20.93+17.1+1.85+10.71+0.69+13.728+1.04+10.08+4.788+1.2768+13.215+0.0511+0 .04875+2.925+0.515)=127.94 kvar总的视在功率S js=(P js2+Q js2)1/2=(203.62592+127.942)1/2=240.48kVA1.3.3、变压器的选择:根据计算的总的视在功率与最大干线功率(以单个开关箱的最大功率逐级计算选择)取大值选择S11-400/10型三相电力变压器,它的容量为400kVA>240.48kVA能够满足使用要求,其高压侧电压为10kV同施工现场外的高压架空线路的电压级别一致。
临时用电量一.编制依据《施工现场临时用电安全技术规范》JGJ46-2005《工程建设标准强制性条文》《建筑工程施工现场供电安全规范》GB50194--93《建筑施工现场安全规范检查标准》JGJ59-99《电力工程电缆设计规范》GB50217《简明施工计算手册》第三版(江正荣、朱国梁编著)二.施工现场用电初步统计1)计算公式工地临时供电包括施工及照明用电两个方面,参照《简明施工计算手册》第三版(江正荣、朱国梁编著)计算公式(17-17)如下:其中η── 用电不均衡系数,取值1.1;P── 计算用电量(kW),即供电设备总需要容量;ΣP1 ── 全部电动机额定用电量之和;ΣP2 ── 电焊机额定用电量之和;ΣP3 ──室内照明设备额定用电量之和;ΣP4 ──室外照明设备额定用电量之和;K1 ── 全部动力用电设备同时使用系数,取0.6;K2 ── 电焊机同时使用系数,取0.6;K3 ── 室内照明设备同时使用系数,取0.8;K4 ── 室外照明设备同时使用系数,取1.0;cosφ ── 用电设备功率因数,取0.75。
2)施工现场用电量统计表经过计算得到ΣP1 = 116 KWΣP2 = 170.2 KWΣP3 = 10 KWΣP4 = 24 KW3)用电量计算P = 1.1×(0.6×116/0.75+0.6×170.2+0.8×10+1×24) = 226.92 KW三.变压器容量计算变压器容量参照《简明施工计算手册》第三版(江正荣、朱国梁编著)计算公式(17-19)如下:P变= 1.05×226.92 = 238.266 KVA结论:一个做业面用200KVA左右,高层四栋,考虑全部开工有四个做业面,将不同时使用系数考虑进去,所以选用800KVA(带环网),位置在图中标注。
另一地块考虑到后期施工,也用800KVA箱变。
电缆选择:(1)如果用电缆。
施工临时用电方案计算书
本计算书根据《建筑施工计算手册》江正荣着、《施工现场临时用电安全技术规范》
JGJ 46-2005。
一、用电量计算:
;
,则有:
---------------------------------------------------------------------------------
序号机具名称型号额定功率(kW) 距离电源(m) 台数
1 塔吊 Q 80.00 20.0 1
---------------------------------------------------------------------------------
路必须采用五芯电缆):
其中 I l──线路工作电流值(A);
U l──线路工作电压值(V),三相四线制低压时取380V。
经过计算得到 I l =2×p0=2×104.16=208.32A。
根据上式计算所得结果,查《建筑施工计算手册》P1084表18-24得出以下铜芯导线类型及其
截面积分可供选择:
TJ型铜裸线──35.00mm2
BX型铜芯橡皮线──50.00mm2
2
46.3;
2
由导线的允许电流及导线的允许电压降校核,分别计算出的导线截面进行比较,取大值;
最后得出如下结果供使用者参考选择:
TJ型铜裸线──35.00mm2
BX型铜芯橡皮线──50.00mm2
BV型铜芯塑料线──50.00mm2
注:三相四线制线路的N线和PE线截面不小于相线截面的50%,单相线路的零线截面与相线截面相同。
目录一、编制说明 (2)二、工程概况 (2)三、临时用电设计思路 (2)四、现场勘测 (3)五、电箱选择 (3)六、线路架设 (3)七、安全用电防火措施 (4)八、施工临时用电计算书 (5).临时用电施工方案一、编制说明(1)本工程所在施工现场范围内无各种埋地管线。
(2)现场采用380V低压供电,设一配电总箱,内有计量设备,采用TN-S系统供电。
(3)根据施工现场用电设备情况,采用电缆埋地敷设,布置位置及线路走向参见临时配电系统图及现场平面图,采用三级配电,两极防护。
(4)按照《JGJ46-2005》规定制定施工组织设计,接地电阻R≤4欧姆。
二、工程概况佛山市三水升达电梯有限公司车间C工程,位于三水芦苞镇工业开发区内,由佛山市三水升达电梯有限公司投资兴建,佛山市三水乐平建筑工程公司承建,广东粤建设计研究院有限公司设计,佛山市营造工程管理有限公司实施监理。
拟建建筑物为钢筋混凝土框架一层,为天然地基基础,建筑面积为:1048.65M2。
建筑高度为:10 M。
三、临时用电设计思路本设计按照建设部JGJ46-2005《施工现场临时用电安全技术规范》为标准。
如执行中需修改必须将修改方案报批后执行。
根据现场实际情况,本工程采用二个回路供电,但所有供电回路值基本相同,实际用作计算只有一条回路。
现场施工用电总视功率44.77 KVA,甲方现有架空线路提供电源,生活区与现场分别为一个独立的接入点。
生活区设备总容量小于10KW,故不纳入计算。
采用中性点直接接地的TN-S接零保护系统、三级配电系统和三级漏电保护系统。
从甲方变压器架空电缆到总配电箱,由一级箱埋电线分别输出供电回路为:1#井架、两台砂浆机、及装饰照明、装饰设备提供电源。
以上设备采用架空电线及埋地电缆从专用电箱供电。
现场上所有的电气设备不带电的金属部分均应与保护零线做好良好的电气连接,不得单纯采用接地保护,保护零线不得小于相线的1/2,且必须用绿黄双色线。
一、工程概况项目名称:XX住宅小区临时用电工程工程地点:XX市XX区XX街道建设单位:XX房地产开发有限公司施工单位:XX建筑工程有限公司二、编制依据1. 《施工现场临时用电安全技术规范》(JGJ46-2005)2. 《低压配电设计规范》(GB50054-2011)3. 《建筑工程施工现场供电安全规范》(GB50194-93)4. 《通用用电设备配电设计规范》(GB50055-93)三、计算内容1. 临时用电负荷计算根据现场施工图纸和设备清单,统计各类用电设备的额定功率,计算总负荷。
(1)照明负荷:照明灯具总功率为10kW,负荷系数取0.7,则照明负荷为7kW。
(2)动力负荷:空调、水泵、风机等设备总功率为50kW,负荷系数取0.7,则动力负荷为35kW。
(3)插座负荷:插座总功率为30kW,负荷系数取0.7,则插座负荷为21kW。
(4)总负荷:照明负荷 + 动力负荷 + 插座负荷 = 7kW + 35kW + 21kW = 63kW。
2. 临时用电线路选择根据总负荷和施工现场实际情况,选择合适的导线截面和电缆类型。
(1)照明线路:照明负荷为7kW,采用RVV-21.5mm²导线,满足安全规范要求。
(2)动力线路:动力负荷为35kW,采用YJV-36mm²电缆,满足安全规范要求。
(3)插座线路:插座负荷为21kW,采用RVV-21.5mm²导线,满足安全规范要求。
3. 临时用电配电箱设计根据现场用电需求,设计临时用电配电箱。
(1)配电箱容量:总负荷为63kW,采用断路器额定电流为100A的配电箱。
(2)配电箱接线:照明、动力、插座分别接入配电箱的不同回路。
(3)配电箱保护:设置漏电保护器、过载保护器等安全保护装置。
四、计算结果1. 临时用电负荷:63kW2. 临时用电线路:照明线路采用RVV-21.5mm²导线,动力线路采用YJV-36mm²电缆,插座线路采用RVV-21.5mm²导线3. 临时用电配电箱:容量为100A,照明、动力、插座分别接入配电箱的不同回路,设置漏电保护器、过载保护器等安全保护装置五、结论根据上述计算,本临时用电工程满足安全规范要求,能够保证施工现场的用电需求。
施工现场临时用电专项施工方案南通建工海安市中医院急救中心、科研教学病房综合楼工程项目部目录一、工程概况 (1)1.1工程基本情况 (1)1.2 各责任主体名称 (1)1.3 环境概况 (1)二、编制依据: (2)三、施工条件 (2)3.1 施工机具 (2)3.2 供电系统设置 (3)四、设计内容和步骤 (3)4.1 现场勘探及初步设计: (3)4.2总配电箱用电计算: (4)4.3 选择总箱的进线截面及进线开关: (11)五、安全用电技术措施 (12)5.1 安全用电技术措施 (12)5.2 安全用电组织措施 (21)六、安全用电防火措施 (22)6.1 施工现场发生火灾的主要原因 (22)6.2 预防电气火灾的措施 (23)七、防雷装置设计 (24)八、接地装置设计 (24)附图1 施工现场平面布置图 (25)施工现场临时用电专项施工方案一、工程概况1.1工程基本情况工程名称海安市中医院急救中心、科研教学病房综合楼工程工程地点海安市宁海中路建筑面积(m2)38453.6 建筑高度(m) 74.1(女儿墙高度)基础类型桩基承台+筏板主体结构框架地上层数17 地下层数 2标准层层高(m) 3.9其它主要层高(m)4.2、4.5、4.8建设单位海安市中医院设计单位浙江大学建筑设计研究院有限公司施工单位南通建工集团股份有限公司监理单位江苏建达全过程工程咨询有限公司代建单位海安市政府投资项目工程建设中心勘察单位江苏苏州地质工程勘察院项目经理赵建明总监理工程师陈之祥技术总工朱江伟安全负责人邓扣准层,主楼地上十七层,总建筑面积为38453.6 m2,其中地上建筑面积27435.6 m2,地下1 1018 m2。
根据设计图纸提供的资料,本工程±0.000相当于绝对标高4.76m,场地自然标高按绝对标高4.26m考虑,即相对标高-0.5m。
1.3 环境概况1.3.1自然环境海安地处亚热带,年平均气温14.5℃,极端最高气温39.4℃,极端最低气温-12℃;年平均降水量1025mm,年平均湿度80%;年蒸发量1360mm,常年主导风向为东南偏东风,按季节不同,春夏季东南风居多,秋季东北到东风,冬季西北风为主导风向。
施工临时用电方案计算书金宸国际工程;工程建设地点:新乡市荣校路;属于剪力墙结构;地上30层;地下2层;建筑高度:89m;标准层层高:2.9m ;总建筑面积:0平方米;总工期:600天。
本工程由新乡万汇房地产有限公司投资建设,北京龙安华诚建筑设计有限公司设计,新乡市地质勘探有限公司地质勘察,河南永安工程管理有限公司监理,曙光控股集团有限公司组织施工;由林德叶担任项目经理,郭腾国担任技术负责人。
一、编制依据《低压配电设计规范》GB50054-95中国建筑工业出版社《建筑工程施工现场供电安全规范》GB50194-93中国建筑工业出版社《通用用电设备配电设计规范》GB50055-93中国建筑工业出版社《供配电系统设计规范》GB50052-95中国建筑工业出版社《施工现场临时用电安全技术规范》JGJ46-2005中国建筑工业出版社《建筑施工安全检查标准》JGJ59-99二、施工条件施工现场用电量统计表:----------------------------------------------------------------------序号机具名称型号安装功率(kW) 数量合计功率(kW)1 塔式起重机 qtz60 31 1 312 混凝土输送泵 HBT80 110 1 1103 木工圆锯 MJ104 3 1 34 钢筋弯曲机 GW40 3 2 65 钢筋调直机 GT6/14 11 1 116 钢筋切断机 QJ407 2 147 插入式振动器 ZX25 0.8 3 2.48 平板式振动器 ZB5 0.5 2 19 交流电焊机 BX3-120-1 9 1 910 建筑施工外用电梯 SCD200/200CJ 44 1 4411 自落式混凝土搅拌机 JD250 11 1 1112 碘钨灯 1 4 413 白炽灯 0.1 20 214 塔式起重机 qtz60 31 1 3115 混凝土输送泵 HBT80 110 1 11016 木工圆锯 MJ104 3 1 317 钢筋弯曲机 GW40 3 2 618 钢筋切断机 QJ40 7 2 1419 钢筋调直机 GT6/14 11 1 1120 插入式振动器 ZX35 0.8 3 2.421 平板式振动器 ZB5 0.5 2 122 交流电焊机 BX3-120-1 9 1 923 建筑施工外用电梯 SCD200/200CJ 44 1 4424 碘钨灯 1 4 425 白炽灯 0.1 20 2----------------------------------------------------------------------三、设计内容和步骤1、现场勘探及初步设计:(1)本工程所在施工现场范围内施工前无各种埋地管线。
(2)现场采用380V低压供电,设一配电总箱,内有计量设备,采用TN-S系统供电。
(3)根据施工现场用电设备布置情况,总箱进线采用导线空气明敷/架空线路敷设,干线采用空气明敷/架空线路敷设,用电器导线采用空气明敷/架空线路敷设。
布置位置及线路走向参见临时配电系统图及现场平面图,采用三级配电,三级防护。
(4)按照《JGJ46-2005》规定制定施工组织设计,接地电阻R≤4Ω。
2、确定用电负荷:(1)、塔式起重机K x=0.2,Cosφ=0.6,tgφ=1.33将J c=40%统一换算到J c1 =25%的额定容量P n=31kWP e=n×(J c/J c1)1/2×P n =1×(0.4/0.25)1/2×31=39.21 kWP js=K x×P e=0.2×39.21=7.84kWQ js=P js×tgφ=7.84×1.33=10.46kvar(2)、混凝土输送泵K x=0.3,Cosφ=0.7,tgφ=1.02P js=0.3×110=33kWQ js=P js×tgφ=33×1.02=33.67kvar(3)、木工圆锯K x=0.65,Cosφ=0.6,tgφ=1.33P js=0.65×3=1.95kW(4)、钢筋弯曲机K x=0.65,Cosφ=0.7,tgφ=1.02P js=0.65×6=3.9kWQ js=P js×tgφ=3.9×1.02=3.98kvar(5)、钢筋调直机K x=0.65,Cosφ=0.7,tgφ=1.02P js=0.65×11=7.15kWQ js=P js×tgφ=7.15×1.02=7.29kvar(6)、钢筋切断机K x=0.65,Cosφ=0.7,tgφ=1.02P js=0.65×14=9.1kWQ js=P js×tgφ=9.1×1.02=9.28kvar(7)、插入式振动器K x=0.3,Cosφ=0.7,tgφ=1.02P js=0.3×2.4=0.72kWQ js=P js×tgφ=0.72×1.02=0.73kvar(8)、平板式振动器K x=0.3,Cosφ=0.7,tgφ=1.02P js=0.3×1=0.3kWQ js=P js×tgφ=0.3×1.02=0.31kvar(9)、交流电焊机K x=0.35,Cosφ=0.4,tgφ=2.29将J c=50%统一换算到J c1 =100%的额定容量P n=S n×Cosφ=9×0.4=3.6kWP e=n×(J c/J c1)1/2×P n =1×(0.5/1)1/2×3.6=2.55 kW P js=K x×P e=0.35×2.55=0.89kWQ js=P js×tgφ=0.89×2.29=2.04kvar(10)、建筑施工外用电梯K x=0.2,Cosφ=0.6,tgφ=1.33将J c=20%统一换算到J c1 =40%的额定容量P n=44kWP e=n×(J c/J c1)1/2×P n =1×(0.2/0.4)1/2×44=31.11 kW P js=K x×P e=0.2×31.11=6.22kW(11)、自落式混凝土搅拌机K x=0.75,Cosφ=0.85,tgφ=0.62P js=0.75×11=8.25kWQ js=P js×tgφ=8.25×0.62=5.11kvar(12)、碘钨灯K x=0.3,Cosφ=0.7,tgφ=1.02P js=0.3×4×1=1.2kWQ js=P js×tgφ=1.2×1.02=1.22kvar(13)、白炽灯K x=1,Cosφ=1,tgφ=0P js=1×2×1=2kWQ js=P js×tgφ=2×0=0kvar(14)、塔式起重机K x=0.85,Cosφ=0.6,tgφ=1.33将J c=40%统一换算到J c1 =25%的额定容量P n=31kWP e=n×(J c/J c1)1/2×P n =1×(0.4/0.25)1/2×31=39.21 kW P js=K x×P e=0.85×39.21=33.33kWQ js=P js×tgφ=33.33×1.33=44.44kvar(15)、混凝土输送泵K x=0.3,Cosφ=0.7,tgφ=1.02P js=0.3×110=33kWQ js=P js×tgφ=33×1.02=33.67kvar(16)、木工圆锯K x=0.65,Cosφ=0.6,tgφ=1.33P js=0.65×3=1.95kWQ js=P js×tgφ=1.95×1.33=2.6kvar(17)、钢筋弯曲机K x=0.65,Cosφ=0.7,tgφ=1.02P js=0.65×6=3.9kWQ js=P js×tgφ=3.9×1.02=3.98kvar(18)、钢筋切断机K x=0.65,Cosφ=0.7,tgφ=1.02P js=0.65×14=9.1kWQ js=P js×tgφ=9.1×1.02=9.28kvar(19)、钢筋调直机K x=0.65,Cosφ=0.7,tgφ=1.02P js=0.65×11=7.15kWQ js=P js×tgφ=7.15×1.02=7.29kvar(20)、插入式振动器K x=0.3,Cosφ=0.7,tgφ=1.02P js=0.3×2.4=0.72kWQ js=P js×tgφ=0.72×1.02=0.73kvar(21)、平板式振动器K x=0.3,Cosφ=0.7,tgφ=1.02P js=0.3×1=0.3kWQ js=P js×tgφ=0.3×1.02=0.31kvar(22)、交流电焊机K x=0.5,Cosφ=0.4,tgφ=2.29将J c=50%统一换算到J c1 =100%的额定容量P n=S n×Cosφ=9×0.4=3.6kWP e=n×(J c/J c1)1/2×P n =1×(0.5/1)1/2×3.6=2.55 kW P js=K x×P e=0.5×2.55=1.27kWQ js=P js×tgφ=1.27×2.29=2.92kvar(23)、建筑施工外用电梯K x=0.85,Cosφ=0.6,tgφ=1.33将J c=20%统一换算到J c1 =40%的额定容量P n=44kWP e=n×(J c/J c1)1/2×P n =1×(0.2/0.4)1/2×44=31.11 kW P js=K x×P e=0.85×31.11=26.45kWQ js=P js×tgφ=26.45×1.33=35.26kvar(24)、碘钨灯K x=0.3,Cosφ=0.7,tgφ=1.02P js=0.3×4×1=1.2kWQ js=P js×tgφ=1.2×1.02=1.22kvar(25)、白炽灯K x=1,Cosφ=1,tgφ=0P js=1×2×1=2kWQ js=P js×tgφ=2×0=0kvar(26)总的计算负荷计算,总箱同期系数取Kx=0.9总的有功功率P js=K x×ΣP js=0.9×(7.84+33+1.95+3.9+7.15+9.1+0.72+0.3+0.89+6.22+8.25+1.2+2+33.33+33+1.95+3. 9+9.1+7.15+0.72+0.3+1.27+26.45+1.2+2)=182.605kW总的无功功率Q js=K x×ΣQ js=0.9×(10.46+33.67+2.6+3.98+7.29+9.28+0.73+0.31+2.04+8.3+5.11+1.22+0+44.44+33.6 7+2.6+3.98+9.28+7.29+0.73+0.31+2.92+35.26+1.22+0)=204.032kvar总的视在功率S js=(P js2+Q js2)1/2=(182.6052+204.0322)1/2=273.813kVA总的计算电流计算I js=S js/(1.732×U e)=273.813/(1.732×0.38)=416.029A3、5号楼线路上导线截面及分配箱、开关箱内电气设备选择:在选择前应对照平面图和系统图先由用电设备至开关箱计算,再由开关箱至分配箱计算,选择导线及开关设备。
