N23-LE-CQ3-CM-010 地下工程施工方案
- 格式:doc
- 大小:170.30 KB
- 文档页数:19
石家庄新客站西广场工程工程施工方案工程名称:石家庄新客站西广场工程方案名称:地下防水工程施工方案编制人:李炎璋审核人:日期:北京建工集团石家庄新客站西广场项目部目录1 编制依据 (1)1。
1施工图纸 (1)1.2主要规程、规范、图集 (1)2 工程概况: (2)2。
1工程总体介绍 (2)2.2地下防水工程设计概况 (2)1、本工程主体结构顶板为广场景观绿化带,故主体结构顶板按一级防水要求设计,主体其他部位(中板除外)及汽车坡道、连通口等按二级防水要求设计 (2)3 施工部署 (3)3.1质量目标 (3)3.2工期安排 (3)3。
3验收程序 (3)4 施工准备 (4)4。
1技术准备 (4)4。
2材料、机具准备 (4)4。
3劳动力准备 (8)5 施工方法 (8)5.1卷材防水施工 (8)5。
2节点做法 (9)5.3水泥基渗透结晶防水层施工 (11)6 质量保证措施 (14)7 施工成品保护措施 (15)8 安全消防措施 (16)1 编制依据1。
1 施工图纸1.2 主要规程、规范、图集2 工程概况:2.1工程总体介绍2.2 地下防水工程设计概况1、本工程主体结构顶板为广场景观绿化带,故主体结构顶板按一级防水要求设计,主体其他部位(中板除外)及汽车坡道、连通口等按二级防水要求设计.2、主体结构采取防水混凝土,其抗渗等级P8,结构顶板、侧墙作附加防水层等加强防水处理。
3、地铁层结构按二级防水要求设计采取防水混凝土,其抗渗等级S10,顶板面采用聚氨酯防水涂料(涂膜厚度大于2。
5mm并覆盖细石混凝土)。
底板侧墙以外防内贴法铺设柔性防水层,柔性防水层采用可与后浇混凝土密粘粘结的单层预铺式冷自粘防水卷材。
3 施工部署3。
1 质量目标本工程采用外防外贴法施工和结构自防水.防水质量达到一级防水标准:不允许渗水,结构表面无湿渍.3。
2 工期安排3。
3 验收程序施工中,每道工序完成后都须按以下验收程序进行验收:专业施工队自检→工长自检→质检员验收→监理验收,经监理工程师验收合格后方可进行下一道工序的施工。
目录一、编制依据 (1)二、工程概况 (2)三、施工条件 (3)四、施工准备 (4)五、地下室底板防水施工 (6)六、地下室外墙防水施工 (11)七、地下室顶板防水施工 (13)八、安全技术要求 (16)九、质量检查 (16)十、成品保护措施 (17)一、编制依据1。
1 黄山中铁滨江名邸工程施工图纸1。
2《地下防水工程质量验收规范》(GB50208-2002)1。
3《地下工程防水技术规范》(GB50108—2008)1。
4《建筑工程施工质量验收统一标准》(GB50300—2001)1.5《地下工程防水技术规范》(GB 50108—2008)1中国中铁四局集团建筑工程有限公司1。
6《黄山中铁滨江名邸工程实施性施工组织设计》1.7《黄山市住宅工程质量通病防治办法》二、工程概况本工程在黄山市屯溪区阳湖镇文峰路与滨江大道交汇处,占地面积43916。
8m2,总建筑面积为84682m2,其中地上面积70682m2,地下面积14000m2,住宅面积59723m2,商业面积10959m2,包含2层的沿街商铺,1栋3层商铺(1—a#楼),2栋6层的商住楼(5#、9#楼),4栋8层住宅楼(1#、2#、3#、4#楼),7栋9层住宅楼(6#、7#、8#、10#、13#、14#、15#楼),2栋12层住宅楼(11#、12#楼),共16栋楼,人防地下室建筑面积13947m2,平时为车库,战时为人员隐蔽所。
拟建场地位于皖南山区的屯溪盆地内,微地貌为率水河右岸Ⅰ级阶地。
场地为农田、沟塘,尚未进行平整,场地地势南北高、东西低,局部稍有起伏。
地表标高127。
28~132。
81米,最大高差约为5。
53米。
其中在场地北部有一条直径约为0。
80米水管沿东西向穿过场地,还有两条深约0。
5~3米、宽约1~2米的水沟沿南北向横穿本场地。
其中地下室底板顶标高约为126.0米,面积较大,地下室底板大多落在④粉土层上、局部落在⑥圆砾、⑤中细砂或③淤泥质粉土(须挖除)或强风化基岩上,地下室基础埋深为—5。
北京经济技术开发区河西区X87R1地块二类居住(配建公共租赁住房)项目一标段地下室防水施工方案审批人:审核人:编制人:中建三局集团有限公司2015年4月8日目录第一章编制依据 (3)1。
现行相关标准、规范、规程 (3)2. 施工图纸 (3)3. 参考图书 (3)第二章工程概况 (4)1. 整体概况 (4)2. 防水概况 (4)第三章施工准备 (6)1. 劳动力准备 (6)2. 材料准备 (6)第四章主要施工方法 (10)1。
地下室自防水混凝土施工 (10)2。
地下室底板防水施工 (14)3。
地下室外墙防水施工 (21)4. 特殊位置处理 (23)第五章成品保护 (26)第六章质量控制标准 (27)1。
防水混凝土质量控制标准 (27)2. 卷材防水质量控制标准 (27)第七章安全文明施工 (30)编制依据1.现行相关标准、规范、规程2.施工图纸3.参考图书工程概况4.整体概况5.防水概况5.1.结构自防水5.2.卷材防水施工准备6.劳动力准备6.1.管理人员组织及职责分工6.2.劳务力计划表7.材料准备7.1.主要材料(1)防水卷材:应有产品合格证书、性能检测报告,材料的品种、规格、性能、见证取样复试;(2)规格:厚度为3mm和4mm,卷材幅宽 1000、每卷面积为10㎡或7。
5平方米;(3)技术性能:1)卷材性能为Ⅱ型.2)成卷卷材应卷紧、卷齐,端面里进外出差不得超过10mm。
成卷卷材在4℃~50℃下展开,在距卷心1000mm长度外不应有10mm以上的裂纹或粘结。
3)卷材表面应平整,不允许有孔洞、缺边和裂口、疙瘩,矿物粒料粒度应均匀一致并紧密地粘附于卷材表面。
4)每卷卷材的接头不应超过一个,较短的一段长度不应少于1000mm,接头处应剪切整齐,并加长150mm。
5)胎基应浸透,不应有未被浸渍处。
(4)主材的物理力学性能1)3mm厚SBS2)4mm厚SBS7.2.辅助材料基层处理剂(冷底子油),涂刷在水泥砂浆基层上,以增加基层与卷材的粘结度,性能应符合下表的要求:7.3.机具准备清理基层的施工工具:铁锹、扫帚、墩布、手锤、钢凿、油开刀、吹尘器等.铺卷材的施工工具:剪刀、弹线盒、卷尺、刮板、滚刷、毛刷、压辊、铁抹子等。

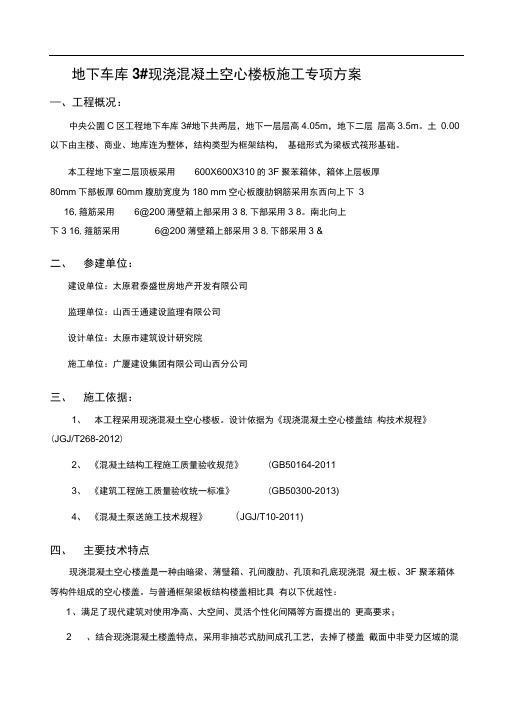

地下车库3#现浇混凝土空心楼板施工专项方案—、工程概况:中央公園C区工程地下车库3#地下共两层,地下一层层高4.05m,地下二层层高3.5m。
土0.00以下由主楼、商业、地库连为整体,结构类型为框架结构,基础形式为梁板式筏形基础。
本工程地下室二层顶板采用600X600X310的3F聚苯箱体,箱体上层板厚80mm下部板厚60mm腹肋宽度为180 mm空心板腹肋钢筋采用东西向上下316,箍筋采用6@200薄壁箱上部采用3 8,下部采用3 8。
南北向上下3 16,箍筋采用6@200薄壁箱上部采用3 8,下部采用3 &二、参建单位:建设单位:太原君泰盛世房地产开发有限公司监理单位:山西壬通建设监理有限公司设计单位:太原市建筑设计研究院施工单位:广厦建设集团有限公司山西分公司三、施工依据:1、本工程采用现浇混凝土空心楼板。
设计依据为《现浇混凝土空心楼盖结构技术规程》(JGJ/T268-2012)2、《混凝土结构工程施工质量验收规范》(GB50164-20113、《建筑工程施工质量验收统一标准》(GB50300-2013)4、《混凝土泵送施工技术规程》(JGJ/T10-2011)四、主要技术特点现浇混凝土空心楼盖是一种由暗梁、薄璧箱、孔间腹肋、孔顶和孔底现浇混凝土板、3F聚苯箱体等构件组成的空心楼盖。
与普通框架梁板结构楼盖相比具有以下优越性:1 、满足了现代建筑对使用净高、大空间、灵活个性化间隔等方面提出的更高要求;2 、结合现浇混凝土楼盖特点,采用非抽芯式肋间成孔工艺,去掉了楼盖截面中非受力区域的混凝土,形成多孔空心楼盖,楼盖的保温隔热和隔声效果明显提高;3 、楼板底可不现凸出的明梁,可省去吊顶,节省了层高及吊顶装修费用;改善了建筑的使用功能,使室内布置更加灵活、更加人性化,符合现代建筑的发展方向;4 、施工模板用量和损耗量均减少,施工简便、速度快,可缩短楼盖施工工期。
五、施工工艺流程3F 聚苯填充箱体现浇混凝土空心楼盖的施工工艺流程见图5.1、墙柱钢筋绑扎、支模测量员定位出挡土墙、框柱控制线,钢筋工依据定位线对钢筋进行调整、绑扎,绑扎完成后经监理验收,具备合模条件。
名士华庭五号地工程(二标段)防雷接地及预留预埋施工方案编制人:审核人:审批人:编制单位:中建三局第三建设工程有限责任公司编制日期:2015年10月15日目录1.编制目的及适用范围 02。
工程概况 02。
1 工程建设概况 02。
2 工程基本情况 03。
编制依据 (1)3。
1 设计图纸及说明 (1)3。
2 标准图集 (1)3。
3 规范及施工组织设计 (1)4.施工准备 (1)4.1 设备采用情况 (1)4。
2 人员素质要求 (2)4。
3 生产准备 (2)5。
施工工艺流程 (2)5.1 工艺流程 (2)5。
2 主要施工内容 (3)5。
3 施工方法 (3)5。
4 接地干线安装 (5)5.5 防雷引下线暗敷设 (6)5.6 避雷带安装 (6)5。
7 均压环安装 (6)5.8 接地测试点安装 (7)5.9 线管线盒套管预留预埋 (7)6.环境和职业健康安全控制 (9)7.质量控制及检验控制 (9)7。
1 施工过程质量控制 (9)7。
2 施工质量检验控制 (11)8。
安全保障措施 (11)9。
过程能力确认 (13)1.编制目的及适用范围为了在工程的施工全过程中科学组织施工,建立正常施工秩序,有计划地开展各部位分项工程的施工,及时做好各项施工准备工作,保证劳动力、材料和机具的及时供应及使用,保证施工的顺利进行及按时保质地完成施工任务,特制定本施工方案。
本方案仅适用于名士华庭五号地工程(二标段)工程防雷接地及预留预埋施工。
2.工程概况2.1工程建设概况2.2工程基本情况南益·名士华庭五号地(二标段)施工总承包机电工程位于天津市塘沽区华庭路以东,福州道沿线以北.本工程总建筑面积159314㎡:其中地上建筑面积116678。
05㎡,包含1-3#楼、12—16#楼以及20-32#楼的4栋高层住宅、10栋多层住宅、7栋商业。
高层住宅地上楼层数为15-33层;多层住宅地上楼层数为7—8层,地库建筑面积42635。
一、编制依据1. 《地铁工程设计规范》(GB 50157-2013)2. 《地铁施工及验收规范》(GB 50299-2018)3. 《建筑基坑支护技术规范》(JGJ 120-2012)4. 工程地质勘察报告5. 施工图纸及相关技术文件二、工程概况本工程为某城市地铁车站基础工程,车站位于城市中心区域,总建筑面积约XX平方米。
车站主体结构为地下两层,采用明挖法施工。
基础工程主要包括土方开挖、支护结构施工、地基处理、垫层施工等。
三、施工总体筹划1. 施工顺序:土方开挖→支护结构施工→地基处理→垫层施工→主体结构施工。
2. 施工组织:采用流水作业、分段施工、平行作业的方式,确保施工进度和质量。
3. 施工时间:计划工期为XX个月。
四、施工方案及技术措施1. 土方开挖(1)采用机械开挖,遵循自上而下、分层开挖的原则。
(2)开挖过程中,及时清理场地,确保施工安全。
(3)加强排水措施,防止地表水渗入基坑。
2. 支护结构施工(1)采用钢支撑和土钉墙相结合的支护结构形式。
(2)钢支撑采用槽钢,间距为XX米,间距可根据地质条件进行调整。
(3)土钉墙采用φ28mm钢筋,间距为XX米,倾角为XX度。
(4)支护结构施工过程中,严格控制施工质量,确保结构稳定。
3. 地基处理(1)地基处理采用旋喷桩加固,桩径为φ500mm,间距为XX米。
(2)旋喷桩施工前,进行试桩试验,确保施工效果。
(3)桩体成桩后,进行桩体质量检测,确保桩体强度。
4. 垫层施工(1)垫层采用C15混凝土,厚度为XX厘米。
(2)垫层施工前,对基底进行清理,确保基底平整。
(3)混凝土浇筑采用平板振动器振捣,确保混凝土密实。
五、质量保证措施1. 严格执行施工规范和质量标准,确保工程质量。
2. 加强原材料检验,确保原材料质量符合要求。
3. 严格控制施工过程,加强现场管理,确保施工安全。
4. 做好施工记录,对施工过程进行跟踪检查。
六、安全保证措施1. 制定安全施工方案,明确安全责任。
中国建筑股份有限公司CHINA STATE CONSTRUCTION ENGRG.CORP.LTD3#楼等2项、5#楼等2项(昌平区北七家镇(未来科技城南区)CP07—0600—0008、0011、0016、0017、0018、0020、0021地块项目)防雷接地施工方案3#楼等2项、5#楼等2项(昌平区北七家镇(未来科技城南区)CP07-0600-0008、0011、0016、0017、0018、0020、0021地块防雷接地施工方案中建二局第三建筑工程有限公司2015 年 12月目录1、编制依据....。
.。
.。
.。
...。
..。
.。
....。
.。
.。
.....。
.....。
..。
.。
32、工程概况。
..。
.。
..。
.。
..。
..。
..。
...。
.。
.。
.。
..。
....。
.。
..。
.。
33、防雷系统及等电位系统设计要求.....。
....。
....。
....。
..。
.。
..。
..44、防雷接地系统施工方法。
.。
...。
......。
.。
..。
..。
..。
.。
.。
.55、等电位系统施工方法。
...。
.。
.。
.....。
.。
......。
.。
.。
..。
.。
..。
.。
116、防雷接地及等电位系统测试要求和方法。
..。
...。
.。
.。
.。
...。
.。
....。
187、质量验收标准及应注意的质量问题.。
.。
.。
.。
.。
.。
.。
...。
.。
.。
..198、现场安全文明施工措施。
..。
....。
.。
...。
.。
..。
..。
...。
.。
...。
..。
.229、成品保护.。
.。
.。
.。
.。
..。
.。
.。
..。
..。
.。
.。
.。
..。
(23)10、附录。
.。
...。
.。
..。
.。
.。
.。
..。
..。
.。
.。
...。
.。
.。
.。
..。
.。
23一、编制依据1.1建设单位提供的北京市昌平区未来科技城A08总部办公项目总平面图、防雷接地基础平面图、接地干线总平面图、各层平面图,建筑设计总说明等;1。
2本工程施工组织设计.1。
杭州铁路东站枢纽西广场机电安装工程防雷接地工程专项施工方案编制:审核:审批:中建三局建设工程股份有限公司(沪)2011年3月2日目录目录 ···································································································· - 1 -1工程概述 ······························································································· - 2 -1.1 工程概况······················································································· - 2 -1.2 编制依据······················································································· - 2 -1.3 设计要求······················································································· - 3 -2施工部署 ······························································································· - 5 -2.1人员组织结构················································································· - 5 -2.2 施工进度计划················································································· - 5 -2.3 劳动力计划···················································································· - 6 -2.4 施工机具······················································································· - 6 -2.5 施工材料计划················································································· - 6 -3施工方案 ······························································································· - 7 -3.1 施工流程······················································································· - 7 -3.2 接地装置安装················································································· - 7 -3.3 接地端子预留················································································ - 10 -3.4 防雷引下线安装············································································· - 12 -3.5 均压环及门窗接地的安装 ································································ - 12 -3.6 接地电阻测试箱的安装 ··································································· - 14 -3.7 接闪器施工··················································································· - 15 -3.8变配电房及弱电机房接地 ································································· - 16 -3.9 建筑物等电位连接 ········································································· - 16 -4.0接地电阻测试 ················································································ - 16 -4质量保证措施························································································ - 16 -4.1 质量及工艺标准············································································· - 16 -4.2 质量通病及防治措施 ······································································ - 18 -4.3质量保证措施 ················································································ - 19 -5安全及文明施工····················································································· - 19 -5.1 安全施工······················································································ - 19 -5.2 文明施工······················································································ - 20 -1工程概述1.1 工程概况工程建设概况一览表1.2 编制依据1.2.1 业主下发施工图及相关文件杭州铁路东站枢纽西广场区块配套设施项目招标文件及答疑文件,电气工程施工图纸;业主、设计、监理和施工单位四方签认的图纸会审记录。
一、编制依据:1.1XXX回迁安置房2#、3#楼及地下车库工程施工组织设计和施工图纸1.2规范、规程、标准、图集二、工程基本情况2.1总体概况本工程XXX回迁安置房2#、3#楼及地下车库工程,建筑性质为民用建筑,位于北京市XX区XXXXX村,西侧为XXX在建小区,北侧是XX路,南侧为XX南路,东侧为已建商业用房位于XXX居住区。
2.2人防工程的战时功能、抗力级别等基本情况本工程中2#住宅楼地下二层为人防层,建筑面积1250㎡,其中掩蔽面积600㎡,掩蔽人数为200人。
抗力等级为5级,防化级别为乙级;本人防工程设一个防护单元,共有2个出入口,其中一个出入口可通过人防通道至室外A4#人防出入口,另外一个备用竖井室外人防出入口,按防倒塌棚架设计。
1#地下汽车库1)人员掩蔽:本工程地下二层中部分为两个防护单元,抗力等级均为六级,防化等级为丙级,战时用作人员掩蔽,平时用作汽车库,防护单元一为2214.81㎡,其中掩蔽面积为1550㎡,掩蔽人数1550人。
防护单元二人防建筑面积为2402.19㎡,其中掩蔽面积1700㎡,掩蔽人数为1700人。
以上两个防护单元均有两个出入口,其中一个出入口可通过人防通道至室外人防出入口,另一个为备用竖井室外人防出入口,按防倒塌棚架设计。
2)物资库:本工程的地下二层北部为防护单元三3971.5㎡,抗力等级为六级,防化等级为丁级;战时用作物资库,平时用作汽车库,防护单元三人防建筑面积为3971.5㎡。
本工程的地下一层北侧为防护单元,防护等级为六级,防化等级为丁级。
战时用作物资库,平时用作汽车库。
防护单元四3971.5㎡。
以上两个防护单元均有2个出入口可通过人防通道至室外人防出入口。
3)抗爆单元的隔墙临战时砌筑。
2.2车库及2#住宅楼人防区、非人防区的位置详见下图:2.3临空墙的位置详见下图:车库地下一层临空墙位置详见图纸结09车库地下二层临空墙位置详见结082#住宅楼临空墙位置详见(2#住宅楼结07)2.4防护单元主要出入口、次要出入口和连通口位置及编号(详见总平面图)2.5染毒区、清洁区和密闭隔墙的位置(详见车库图纸建02、建03)三、围护结构质量控制:3.1人防围护结构防护密闭性能的质量控制3.1.1螺栓孔1)本工程中的人防区域,外墙为防水混凝土,模板设计均采用带有止水环的Φ14的钢筋进行加固模板,具体样式如下图:混凝土墙体拆模板后,及时将穿墙螺栓切除。
目录1. 编制依据 (2)2.工程概况 (3)3. 施工安排 (5)4. 施工准备 (6)5. 主要施工方法及措施 (7)6.质量要求及控制措施 (8)7.成品保护措施 (8)8.季节施工要求 (9)9.安全生产、文明施工、环保注意事项 (10)10.施工技术资料的管理 (10)防雷与接地工程施工方案1.编制依据1.1施工图1.2主要规程、规范:2.工程概况:2.1工程总体概况2.2结构、建筑设计概况:2.3防雷与接地设计概况2.3.1本工程强电、弱电及建筑物防雷各系统的接地,采用共用接地装置,利用基础底板承台桩基内的钢筋作为自然接地装置,利用建筑物外侧钢结构柱或混凝土结构主钢筋作防雷引下线。
2.3.2基础底板作为共用接地装置的基准电位,基础底板内人工敷设φ16镀锌圆钢与承台桩基和柱内钢筋互联,构成网状。
2.3.3变配电室、发电机房、UPS室、多用途竖井、强电小间、PCR、DCR、SCR、消防控制中心等均设等电位连接箱,通过铜缆与接地电缆转接箱相联,或通过结构主筋、钢柱与接地体联结,电缆转接箱与接地装置采用化学热融焊接相联。
所有配电箱柜依据设计规范要求做等电位连接。
2.3.4变配电室、发电机房、UPS室、多用途竖井、强电小间、PCR、DCR、SCR、消防控制中心内设金属网格与等电位连接箱相联。
2.3.5建筑物内所有外露金属构件或金属管道通过接地干线、保护线干线、等电位联接干线与主等电位铜排联接。
2.4 此方案内容只包括接地装置、部分防雷引下线、底板等电位网格、地下等电位电缆转接箱预留板等内容。
防雷与接地系统地上部分及机房、建筑物内等电位联接工程待设计图完善后再编制。
2.5因本工程分段出图,防雷与接地系统有可能有不同程度修改。
如有修改,本方案再做及时调整。
3.施工安排(根据土建施工计划,随时调整,配合进行。
)3.1施工进度计划3.1.1由于本工程施工面积大,施工点多。
因此,施工管理人员要经常巡视现场,及时配合结构施工,避免因施工准备不足耽误土建结构进度和遗漏施工点。
Contents目录一、Project overview工程概况.........................................................1-3二、Fabrication reference编制依据.........................................................3-3三、Construction principle施工准备.........................................................3-3四、Underground engineering construction process地下工程施工流程..............................................4-9五、Underground engineering construction process and construction methods地下工程施工工艺及施工方法...........................................9-13 六、Safety attentions安全注意事项....................................................16-16一、Project Overview工程概况This project is Linde Huayi(Chongqing) Gases Co., Ltd 1 Billion Nm3/year Syngas CO/H2 project, located in Chongqing(Changshou) Chemical Industry Park, and the main work contains substation、office、parts stock、compression unit 、power absorption unit、washing unit、raw material gas compressor unit 、high temperature shift unit etc..本项目为林德化医(重庆)气体有限公司10 亿Nm3/年合成气制备CO/H2 项目,位于重庆(长寿)化工园区内,其中主体工作包括变电所、办公楼、备件仓库、压缩单元、变电吸附单元、洗涤单元、原料气压缩单元、高温变换单元等。
The underground engineering projects include: underground pipeline comprises a circulating water system, water system, water supply and drainage system, the total extension of about 1950m pipeline.本项目地下工程包括:地下管道包括循环水系统、工业水系统、给排水系统,各管道共计延长米约1950m。
Fire fighting pipe: integration of the project in the project area is set DN500 ring fire fighting pipe, and is arranged along SS 150/80-1.6 ground outdoor fire hydrant and a switching valve. This project from the integration of annular fire tube online leads to 4 DN300 fire tube, along the border area road pulling, and in the area of fire ring pipe is arranged along 5 SS150/80-1.6 type outdoor ground hydrants and a switching valve.消防管网:一体化项目在本项目界区外已设置DN500环状消防管网,并沿线设置SS 150/80-1.6型地上式室外消火栓及切换阀门。
本项目从一体化环状消防管网上引出4根DN300消防管,沿界区道路边敷设,并在界区内消防环管沿线设置5只SS150/80-1.6型室外地上式消火栓及切换阀门。
Rainwater drainage pipe network: diameter of less than 600 is made of polyethylene (PE) spiral corrugated tube, heat shrinkable belt connection. DN>600 uses reinforced concrete pipes, cement mortar socket connection.雨水排水管网:直径小于600采用聚乙烯(PE)螺旋波纹管,热收缩带连接。
DN>600采用钢筋混凝土管,水泥砂浆承插连接。
N1DEA washing unit 1, 2 production sewage pipeline using ductile iron pipes, rubber ring seal connection, a pressure production sewage pipe with carbon steel pipe, welded or flanged connections, substation accident oil fire water pipeline using carbon steel pipe, welded or flanged connections, sewage pipe with polyethylene spiral corrugated tube, (PE) thermal contraction belt connection.N1DEA洗涤单元1、2生产污水管道采用球墨铸铁管,橡胶圈密封连接,有压生产污水管道采用碳钢管,焊接或法兰连接,变电所事故含油消防废水管道采用碳钢管,焊接或法兰连接,生活污水管采用聚乙烯(PE)螺旋波纹管,热收缩带连接。
Factory production: the use of carbon steel pipe, welded pipe, outdoor living water (PE) buried part of the steel mesh skeleton PE composite pipe, electric melting connection.厂区生产水管:采用碳钢管,焊接,室外生活水管(PE)埋地部分采用钢丝网骨架PE复合管,电热熔连接。
Production sewage: made of ductile cast iron pipes, rubber ring. Pressure production wastewater using carbon steel pipe, welded or flanged connections.生产污水:采用球墨铸铁管道,橡胶圈密封连接。
有压生产污水采用碳钢管,焊接或法兰连接。
In order to ensure the construction safety、quality、high efficiency、especially the preparation of the scheme.为保证施工安全、优质、高效完成,特编制本方案。
二、Fabrication reference编制依据The design drawing of the project 本工程项目设计图文件Foundation survey Report地基勘察报告《Building the foundation and basic construction and acceptance specification》《建筑地基与基础施工及验收规范》.........................................(GBJ202-2002)《Engineering surveying specification》《工程测量规范》........................................................(GB50026-2007)《Construction quality acceptance specification of masonry》《砌体工程施工质量验收规范》............................................(GB50203-2002)《Construction quality acceptance specification of concrete structure》《混凝土结构工程施工质量验收规范》......................................(GB50204-2002)《Acceptance unified standard of engineering construction quality》《建筑工程施工质量验收统一标准》........................................(GB50300-2001)《Construction and acceptance specification of drainage pipeline》《给水排水管道工程施工及验收规范》..................................... (GB50268-2008) 《Buried plastic drainage pipeline engineering》《埋地塑料排水管道工程技术规程》....................................(DG/TJ08-308-2002)三、Construction principle施工准备The organization construction and technical personnel shall familiar with the drawings, construction technology and technical standard; understand the design requirements to meet the technical standards, clear process.组织施工技术人员熟悉图纸、施工工艺及有关技术规范,了解设计要求达到的技术标准、明确工艺流程。
