工程量计算书(结算)
- 格式:doc
- 大小:11.00 KB
- 文档页数:1
工程量计算书一、土石方工程1.平整场地清单量S=49.2*(16.2-1.8-1.8+0.2)+(3.7+0.2)*0.8*2+(3.8*2+0.2)*0.8*2+(3.1+2.6+3.1+0.2)*1*3+(2.6+0.2)*0.8*3=682.2m²计价量S′=682.2+(49.2+2*2)*2+(16.2-1.8-1+0.2+2)*2*2+3.7*2*2+3.1*2*6+2.6*2*3+(1.2*2+1.6*2+2)*3=963.8m²2.挖一般土方:挖土深度6.6-0.7=5.9mV=[(49+1.4*2)*(16.2-1-1.8+0.5*2)+(3.1*2+2.6+1.7+1)*(0.5+1.25)*2+(3.1*2+2.6+1.1*2)*(0.5+1.25)]*5.9+(3.3*3.6*3+5.95*2.6+2.6*4.4*2)*0.2=5526.453m³计价量:考虑工作面,地下室做防水,基础外边外扩1m,放坡系数:机械开挖,坑内作业,选择0.33V′=(A+2C+KH)*(B+2C+KH)*H+1/3*K²H³=(49+1.4*2+2*0.7+0.33*5.53)*(15.2+0.5+0.45+2*0.7+0.33*5.53)*5.53+1/3*0.33²*5.53³=5901.68m³3.挖基坑土方V=(2.2+0.7*2)*(2.6+0.7*2)*3*(8.18-5.53-0.7)=84.24m³4.土方回填V(垫层)=[(49+1.4*2+0.1*2)*(13.4+0.5*2+0.1*2)+(1+1.25-0.5)*(1.2+3.1*2+ 2.6+0.5+1+0.1*2)*2+(1.25+1+0.5)*(10+1.1*+0.1*2)]*0.1=84.89m³V(防水找平层)=848.9*0.07=59.423m³V(褥垫层)=850.75*0.2=170.15m³V(满堂基础)=[(49+1.4*2)*(13.4+1)+11.5*1.75*2+12.2*1.75]*0.7+(3.3*3.6*3+5.95*2.6+2.6*4.4*2)*0.9+43.2*1.95=736.095m³V(地下室)=[49.2*13.6+(3.1*2+2.6+0.2)*1.2*3]*(5.53-0.7)=3388.35m³V(回填)=5526.45+84.24-84.89-59.423-170.15-736.095-3388.35=1171.78m³5.余方弃置V=5526.45+84.24-1171.78=4438.91m³二、砌筑工程:标准层第四层1.砌体墙 200厚外墙1轴:V=[5.6(长度)*2.9(墙高)*0.2(墙厚)-0.72(扣窗)-0.532(扣梁)]*2(根数)=3.992m³V=(3.8*2.9*0.2-0.3-0.366)*2=2.076m³J轴:V=(1.9*2.9*0.2-0.54-0.19)*3=1.116m³V=(2.4*2.9*0.2-0.285-0.24)*3=2.601m³V=(1.9*2.9*0.2-0.54-0.19)*3=1.116m³H轴:V=(3*2.9*0.2-0.54-0.3)*2=1.8m³V=(2.1*2.9*0.2-0.45-0.21)*4=2.232m³V=(3.4*2.9*0.2-0.27-0.258)*4=5.776m³V=(1.4*2.9*0.2-0.126)*2=1.372m³F轴:V=(2*2.9*0.2-0.21-0.16)*4=3.16m³A轴:V=(8.8*2.9*0.2-2.312-0.688)*3=6.312m³V=(0.9*2.9*0.2-0.238-0.072)*6=1.272m³B轴:V=(2.2*2.9*0.2-0.68-0.22)*2=0.752m³V=(6.1*2.9*0.2-1.36-0.61)*2=3.136m³2.砌体墙 200厚内墙G轴:V=[6.6(长度)*2.9(墙高)*0.2(墙厚)-0.756(扣门)-0.462(扣梁)]*2=5.22m ³V=(5.7*2.9*0.2-0.756-0.387)*4=8.652m³F轴:V=(2*2.9*0.2-0.484-0.16)*3=1.548m³V=0.9*2.9*0.2*4=2.088m³E轴:V=(3.2*2.9*0.2-0.212)*4=6.576m³C轴:V=(7.4*2.9*0.2-2.76-0.868)*3=9.444m³3轴:V=(6.6*2.9*0.2-0.588(扣洞)-0.504-0.632)*6=12.624m³V=(4.2*2.9*0.2-0.378(扣门)-0.406(扣梁))*6=9.912m³4轴:V=(3.05*2.9*0.2-0.216(扣门)-0.291(扣梁))*6=7.572m³V=(1.4*2.9*0.2-0.42(扣门))*6=2.352m³V=0.7*2.9*0.2*6=2.436m³5轴:V=(6.8*2.9*0.2-0.51(扣梁))*3=10.302m³V=(1*2.9*0.2-0.08)*3=1.5m³10轴:V=(5.8*2.9*0.2-0,566)*2=5.596m³3.砌体墙 100厚内墙F轴:V=(3.5*2.9*0.1-0.1225(扣梁))*2=0.785m³2轴:V=(2.1*2.9*0.1-0.168(扣门)-0.06(扣梁))*6=2.286m³4轴:V=1.2*2.9*0.1*6=2,088m³V=(1.75*2.9*0.1-0.147(扣门)-0.0525(扣梁))6=1.848m³D轴:V=(2.45*2.9*0.0.0813(扣梁))*6=3.7752m³三、混凝土及钢筋混凝土工程:标准层第四层1.矩形梁:L8:V=0.2*0.35*3.9=0.273m 模板:S=0.2*3.9+0.35*3.9*2=3.51㎡L4:V=0.2*0.35*3.9=0.273m³模板:S=0.2*3.9+0.35*3.9*2=3.51㎡L10:V=0.2*0.35*15.5=1.085m³模板:S=0.2*15.5+0.35*15.5*2=11.63㎡L1:V=0.2*0.3*2.2*2=0.264m³模板:S=(0.2*2.2+0.3*2.2*2)*2=3.52㎡XL2:V=0.2*0.4*0.9*6=0.432m³模板:S=(0.2*0.9+0.4*0.9*2)*6=5.4㎡L3:V=0.2*0.4*8.8*3=2.112m³模板:S=(0.2*8.8+0.4*8.8*2)*3=26.4㎡L2:V=0.2*0.5*7.2*3=2.16m³模板:S=(0.2*7.2+0.5*7.2*2)*3=25.92㎡L5:V=0.2*0.35*7.8=0.546m³模板:S=0.2*7.8+0.35*7.8*2=7.02㎡XL4:V=0.2*0.45*1.6*2=0.288m³模板:S=(0.2*1.6+0.45*1.6*2)*2=3.52㎡L9:V=0.2*0.35*3.9=0.273m 模板:S=0.2*3.9+0.35*3.9*2=3.51㎡L12:V=0.2*0.35*15.5=1.085m³模板:S=0.2*15.5+0.35*15.5*2=11.63㎡L7:V=0.2*0.35*3.9=0.273m 模板:S=0.2*3.9+0.35*3.9*2=3.51㎡L6:V=0.2*0.35*7.8=0.546m³模板:S=0.2*7.8+0.35*7.8*2=7.02㎡L13:V=0.2*0.3*1.9*4=0.456m³模板:S=(0.2*1.9+0.3*1.9*2)*4=6.08㎡L11:V=0.2*0.35*14.6=1.022m³模板:S=0.2*14.6+0.35*14.6*2=13.14㎡KL1:V=0.2*0.3*2.2*4=0.528m³模板:S=(0.2*2.2+0.3*2.2*2)*4=7.04㎡KL2:V=0.2*0.3*1.8*2=0.216m³模板:S=(0.2*1.8+0.3*1.8*2)*2=2.88㎡LLK26:V=0.2*0.5*3=0.3m³模板:S=0.2*3+0.5*3*2=3.6㎡LLK2:V=0.2*0.5*5.6*2=1.12m³模板:S=(0.2*5.6+0.5*5.6*2)*2=13.44㎡LLK3:V=0.2*0.5*11*2=2.2m³模板:S=(0.2*11+0.5*11*2)*2=26.4㎡LLK1:V=0.2*0.5*3.8=0.38m³模板:S=0.2*3.8+0.5*3.8*2=4.56㎡LLK12:V=0.2*0.5*2.5=0.25m³模板:S=0.2*2.5+0.5*2.5*2=3㎡LLK19:V=0.2*0.4*3.1=0.248m³模板:S=0.2*3.1+0.4*3.1*2=3.1㎡LLK4:V=0.2*0.5*4.5*2=0.9m³模板:S=(0.2*4.5+0.5*4.5*2)*2=10.8㎡LLK24:V=0.2*0.4*2*3=0.48m³模板:S=(0.2*2+0.4*2*2)*3=6㎡LLK5:V=0.2*0.5*4.5*4=1.8m³模板:S=(0.2*4.5+0.5*4.5*2)*4=21.6㎡LLK7:V=0.2*0.5*4.4*4=1.76m³模板:S=(0.2*4.4+0.5*4.4*2)*4=21.12㎡LLK20:V=0.2*0.5*2.1*4=0.84m³模板:S=(0.2*2.1+0.5*2.1*2)*4=10.08㎡LL1:V=0.2*0.5*1.9*4=0.76m³模板:S=(0.2*1.9+0.5*1.9*2)*4=9.12㎡LLK31:V=0.2*0.5*2.4*3=0.72m³模板:S=(0.2*2.4+0.5*2.4*2)*3=8.64㎡LLK25:V=0.2*0.4*4.2*2=0.84m³模板:S=(0.2*4.2+0.4*4.2*2)*2=8.4㎡LLK8:V=0.2*0.4*3.5*4=1.12m³模板:S=(0.2*3.5+0.4*3.5*2)*4=14㎡LL2:V=0.2*0.5*1*3=0.3m³模板:S=(0.2+0.5*2)*3=3.6㎡LLK16:V=0.2*0.6*7.4=0.888m³模板:S=0.2*7.4+0.6*7.4*2=10.36㎡LLK21:V=0.2*0.35*6.5*2=0.91m³模板:S=(0.2*6.5+0.35*6.5*2)*2=11.7㎡LLK6:V=0.2*0.5*5.7*4=2.28m³模板:S=(0.2*5.7+0.5*5.7*2)*4=27.36㎡LLK13:V=0.2*0.5*6.4=0.64m³模板:S=0.2*6.4+0.5*6.4*2=7.68㎡LLK9:V=0.2*0.5*5.9*2=1.18m³模板:S=(0.2*5.9+0.5*5.9*2)*2=14.16㎡LLK22:V=0.2*0.4*6.5*2=1.04m³模板:S=(0.2*6.5+0.4*6.5*2)*2=13㎡LL3:V=0.2*0.5*1.9*2=0.38m³模板:S=(0.2*1.9+0.5*1.9*2)*2=4.56㎡LLK29:V=0.2*0.5*3=0.3m³模板:S=0.2*3+0.5*3*2=3.6㎡LLK23:V=0.2*0.4*3.1=0.248m³模板:S=0.2*3.1+0.4*3.1*2=3.1㎡LLK11:V=0.2*0.5*3.8=0.38m³模板:S=0.2*3.8+0.5*3.8*2=4.56㎡LLK15:V=0.2*0.5*2.5=0.25m³模板:S=0.2*2.5+0.5*2.5*2=3㎡LLK14:V=0.2*0.5*6.4=0.64m³模板:S=0.2*6.4+0.5*6.4*2=7.68㎡LLK17:V=0.2*0.6*7.4=0.888m³模板:S=0.2*7.4+0.6*7.4*2=10.36㎡2.直形墙Q-1 V1=1.7(长度)*2.9(墙高)*0.2(墙厚)*16(个数)=15.776m³模板:V=1.7*(2.9-0.1)*2*16=152.32㎡V2=0.6*2.9*0.2*16=5.568m³模板:S=0.6*(2.9-0.12)*2*16=53.376㎡ V3=3.8*2.9*0.2*2=4.408m³模板:S=3.8*(2.9-0.1)*2*2=42.56㎡ V4=0.5*2.9*0.2*2=0.58m³模板:S=0.5*(2.9-0.1)*2*2=5.6㎡V5=0.3*2.9*0.2*6=1.044m³模板:S=0.3*(2.9-0.12)*2*6=10.01㎡ V6=2.2*2.9*0.2*8=10.208m³模板:S=2.2*(2.9-0.12)*2*8=97.856㎡ V7=0.8*2.9*0.2*4=1.856m³模板:S=0.8*(2.9-0.1)*2*4=17.92㎡ V8=1*2.9*0.2*2=1.16m³模板:S=1*(2.9-0.1)*2*2=11.2㎡Q-2 V1=1.7*2.9*0.2*16=15.776m³模板:S=1.7*(2.9-0.1)2*16=152.32㎡ V2=0.6*2.9*0.2*16=5.568m³模板:S=0.6*(2.9-0.1)*2*16=53.76㎡4.板现浇板 100厚V1=3.5*2.8*0.1*2=1.96m³模板:S=(3.5-0.2)*(2.8-0.2)*2=17.16㎡V2=2.3*2*0.1*2=0.92m³模板:S=(2.3-0.2)*(2-0.2)*2=7.56㎡V3=3.5*2*0.1*2=1.4m³模板:S=(3.5-0.2)*(2-0.2)*2=11.88㎡V4=2.3*1.6*0.1*2=0.736m³模板:S=(2.3-0.2)*(1.6-0.2)*2=5.88㎡V5=3.5*4*0.1*2=2.8m³模板:S=(3.5-0.2)*(4-0.2)*2=25.08㎡V6=1*2*0.1*6=1.2m³模板:S=(1-0.2)*(2-0.2)*2=2.88㎡V7=1*1.6*0.1*6=0.96m³模板:S=(1-0.2)*(1.6-0.2)*6=6.72㎡V8=2.9*3.8*0.1*6=6.612m³模板:S=(2.9-0.2)*(3.8-0.2)*6=58.32㎡V9=4.2*1.6*0.1*6=4.032m³模板:S=(4.2-0.2)*(1.6-0.2)*6=33.6㎡V10=2.4*2*0.1*3=1.44m³模板:S=(2.4-0.2)*(2-0.2)*3=11.88㎡V11=2.6*2.8*0.1*4=2.912m³模板:S=(2.6-0.2)*(2.8-0.2)*4=24.96㎡V12=1.4*2*0.1*4=1.12m³模板:S=(1.4-0.2)*(2-0.2)*4=8.64㎡V13=3.6*2*0.1*4=2.88m³模板:S=(3.6-0.2)*(2-0.2)*4=24.48㎡V14=2.4*1.6*0.1*4=1.536m³模板:S=(2.4-0.2)*(1.6-0.2)*4=12.32㎡V15=3.6*4*0.1*4=5.76m³模板:S=(3.6-0.2)*(4-0.2)*4=51.68㎡现浇板 120厚V1=(2.9*2.2+3.1*2)*0.12*6=9.058m³模板:S=[(2.9-0.2)*(2.2-0.2)+(3.1-0.2)*(2-0.2)]*6=63.72㎡V2=4.2*5*0.12*6=15.12m³模板:S=(4.2-0.2)*(5-0.2)*6=115.2㎡钢筋工程量:剪力墙:1.Q-1 ①水平筋 L=1800-2*15+10d*2=1930mm=1.93mN=[(2900-50)/200+1]*2=16*2=32根(向上取整+1)质量=0.00617*8*8*1.93*32=24.39kg②纵筋L=2900+1.2Lae=2900+1.2*35*10=3320mm=3.32mN=[(900-200*2+15*2+6*2)/200+1]*2=8根(向上取整+1)质量=0.00617*10*10*3.32*8=16.39kg③拉筋L=200-2*15+2*(5d+1,9d)=253mm质量=0.00617*6*6*0.253*18=1.02kgGBZ-1 ①纵筋L=2900+Lle=2900+49*12=3488mm=3.488mL=2900-(Lle+0.3Lle)+0.3Lle+Lle+Lle=3.488mm质量=0.00617*12*12*3.49*7*2=43.4kg②箍筋L=(700+200)*2-8*20+11.9d*2=1830.4mm=1.83mN=2900/200+1=16根质量=0.00617*8*8*1.83*16=11.56kgL=(500+200)*2-8*20+11.9d*2=1382.8mm=1.38m质量=0.00617*6*6*1.38*16=4.9kgL=200-2*20+[1.9d+max(10d,75)]*2=333mm=0.333m质量=0.00617*6*6*0.333*32=2.42kgGBZ-3 ①纵筋L=2900+Lle=2900+49*12=3488mm=3.488mL=2900-(Lle+0.3Lle)+0.3Lle+Lle+Lle=3.488mm质量=0.00617*12*12*3.49*6=18.6kg②箍筋L=(400+200)*2-8*20+11.9d*2=1182.8mm=1.183mN=2900/200+1=16根质量=0.00617*8*8*1.183*16=4.2kgL=200-2*20+[1.9d+max(10d,75)]*2=333mm=0.333m 质量=0.00617*6*6*0.333*16=1.21kgD=6 理论质量小计 (1.02+4.9+2.42+4.2+1.21)*10=137.5kgD=8 理论质量小计 (11.56+24.39)*10=359.5kgD=10 理论质量小计 16.39*10=163.9kgD=12 理论质量小计 (43.4+18.6)*10=620kg。
合同编号:LDW-2010-001H 编号:L-001-1 34联测内容:合同编号:LDW-2010-001H 编号:L-001-2 89联测内容:合同编号:LDW-2010-001H 编号:L-001-31415联测内容:合同编号:LDW-2010-001H 编号:L-002-12021联测内容:合同编号:LDW-2010-001H 编号:L-002-22627联测内容:合同编号:LDW-2010-001H 编号:L-002-33233联测内容:“四方”现场联测记录(计算)单3738合同编号:LDW-2010-001H 编号:L-002-4 39联测内容:“四方”现场联测记录(计算)单4344合同编号:LDW-2010-001H 编号:L-002-5 45联测内容:“四方”现场联测记录(计算)单4950合同编号:LDW-2010-001H 编号:L-002-6 51联测内容:“四方”现场联测记录(计算)单5556合同编号:LDW-2010-001H 编号:L-003-1 57联测内容:“四方”现场联测记录(计算)单6162合同编号:LDW-2010-001H 编号:L-003-2 63联测内容:“四方”现场联测记录(计算)单6768合同编号:LDW-2010-001H 编号:L-003-3 69联测内容:“四方”现场联测记录(计算)单7374合同编号:LDW-2010-001H 编号:L-003-4 75联测内容:“四方”现场联测记录(计算)单7980合同编号:LDW-2010-001H 编号:L-004-1 81联测内容:“四方”现场联测记录(计算)单8586合同编号:LDW-2010-001H 编号:L-004-2 87联测内容:“四方”现场联测记录(计算)单9192合同编号:LDW-2010-001H 编号:L-004-3 93联测内容:“四方”现场联测记录(计算)单9798合同编号:LDW-2010-001H 编号:L-005-1 99联测内容:“四方”现场联测记录(计算)单103104合同编号:LDW-2010-001H 编号:L-005-2 105联测内容:“四方”现场联测记录(计算)单109110合同编号:LDW-2010-001H 编号:L-006-1 111联测内容:“四方”现场联测记录(计算)单115116合同编号:LDW-2010-001H 编号:L-007-1 117联测内容:“四方”现场联测记录(计算)单121122合同编号:LDW-2010-001H 编号:L-007-2 123联测内容:“四方”现场联测记录(计算)单127128合同编号:LDW-2010-001H 编号:L-008-1 129联测内容:“四方”现场联测记录(计算)单133134合同编号:LDW-2010-001H 编号:L-008-2 135联测内容:“四方”现场联测记录(计算)单139140合同编号:LDW-2010-001H 编号:L-008-3 141联测内容:“四方”现场联测记录(计算)单145146合同编号:LDW-2010-001H 编号:L-009-1 147联测内容:“四方”现场联测记录(计算)单151152合同编号:LDW-2010-001H 编号:L-009-2 153联测内容:“四方”现场联测记录(计算)单157158合同编号:LDW-2010-001H 编号:L-009-3 159联测内容:“四方”现场联测记录(计算)单163164合同编号:LDW-2010-001H 编号:L-0010-1 165联测内容:“四方”现场联测记录(计算)单169170合同编号:LDW-2010-001H 编号:L-0010-2 171联测内容:“四方”现场联测记录(计算)单175176合同编号:LDW-2010-001H 编号:L-0011-1 177联测内容:“四方”现场联测记录(计算)单181182合同编号:LDW-2010-001H 编号:L-0011-2 183联测内容:“四方”现场联测记录(计算)单187188合同编号:LDW-2010-001H 编号:L-0011-3 189联测内容:191深圳2号区域绿道二线段Ⅰ标段“四方”现场联测记录(计算)单192193合同编号:LDW-2010-001H 编号:L-001-2 联测内容:194。

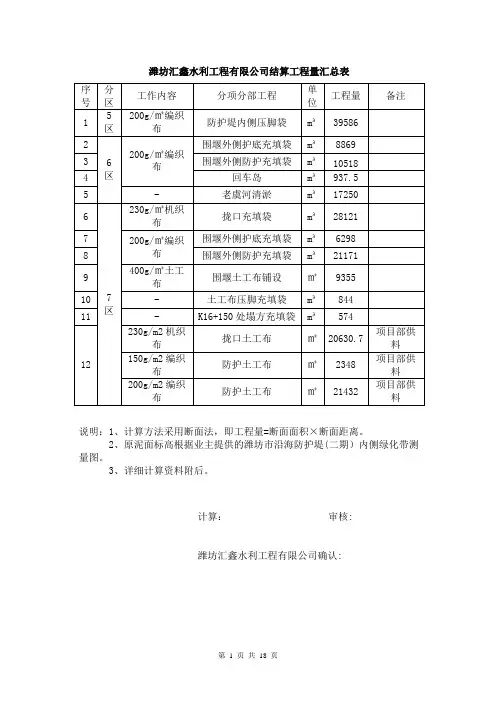

潍坊汇鑫水利工程有限公司结算工程量汇总表说明:1、计算方法采用断面法,即工程量=断面面积×断面距离。
2、原泥面标高根据业主提供的潍坊市沿海防护堤(二期)内侧绿化带测量图。
3、详细计算资料附后。
计算:审核:潍坊汇鑫水利工程有限公司确认:潍坊汇鑫水利工程有限公司结算工程量计算书一、五区防护堤压脚充填袋工程量潍坊沿海防护堤(二期)内侧加固吹填工程施工标段三五区防护堤压脚袋工程量计算书断面2-9见附图2。
外坡比为1:4。
计算:审核:潍坊汇鑫水利工程有限公司确认:二、六区外侧护底充填袋工程量潍坊沿海防护堤(二期)内侧加固吹填工程施工标段三计算:审核:潍坊汇鑫水利工程有限公司确认:三、六区外侧防护充填袋工程量潍坊沿海防护堤(二期)内侧加固吹填工程施工标段三计算:审核:潍坊汇鑫水利工程有限公司确认:四、7区护底充填袋工程量潍坊沿海防护堤(二期)内侧加固吹填工程施工标段四计算:审核: 潍坊汇鑫水利工程有限公司确认:五、七区外侧防护充填袋工程量潍坊沿海防护堤(二期)内侧加固吹填工程施工标段四(K15+000-K17+000)外侧防护充填袋工程量计算书计算:审核:潍坊汇鑫水利工程有限公司确认: 六、七区合拢口工程量1、K16+800大小合拢口K16+800大小拢口工程量计算:审核:潍坊汇鑫水利工程有限公司确认:2、K16+850合拢口K16+850处围堰合拢口工程量明细表计算:审核:潍坊汇鑫水利工程有限公司确认:3、K16+700处拢口工程量K16+700处拢口工程量计算:审核:潍坊汇鑫水利工程有限公司确认:4、K16+000处拢口工程量K16+000处拢口工程量计算:审核:潍坊汇鑫水利工程有限公司确认:计算:审核:潍坊汇鑫水利工程有限公司确认:6、K16+150处塌方工程量计算:审核:潍坊汇鑫水利工程有限公司确认:七、400g/㎡土工布使用明细400g/㎡土工布使用明细表统计:审核:潍坊汇鑫水利工程有限公司确认:八、老虞河闸清淤工程量老虞河闸清淤计算书计算:审核:潍坊汇鑫水利工程有限公司确认:九、六区回车岛工程量潍坊沿海防护堤内侧加固吹填工程施工标段三六区回车岛工程量计算书计算:审核:潍坊汇鑫水利工程有限公司确认:十、材料明细潍坊汇鑫水利工程有限公司结算材料汇总表统计:审核:潍坊汇鑫水利工程有限公司确认:。
工程量计算书一、拦河坝工程1.1.1 土方开挖(如下图)拦河坝下游坝坡(桩号0+000-0+193.5)长为193.5米,开挖深度为1米。
开挖宽度为:(97.5-83.3)×2.3+1=33.66m开挖工程量为:0+010~0+05033.66×40×0.5×1.2=807.8 m3(193.5-50)×1.2×33.66=5796.3m3合计:807.8+5796.3=6604.1 m31.1.2拦河坝上游旧石拆除翻修(厚30cm)、反滤料找平补齐(厚25cm)及旧干砌石铺筑(厚30cm)(如以下简图)1、0+030-0+172.6 (长142.6m、宽10.6 m) (如下图)干砌石拆除工程量:142.6×10.6×0.3=453.5m3旧干砌石砌筑工程量:142.6×10.6×0.3=453.5m3反滤料找平补齐工程量:142.6×10.6×0.25=377.9 m32、0+016-0+028.4 (长12.4m、宽10.6 m) (如下图)干砌石拆除工程量:12.4×10.6×0.3=39.4m3干砌石砌筑工程量:12.4×10.6×0.3=39.4m3反滤料找平补齐工程量:12.4×10.6×0.25=32.9 m33、上游马道平台工程量0+030-140.2(长110.2m、宽2m)(如下图)。
干砌石拆除工程量:2×74.2×0.3+36×2×0.3×0.5= 55.3m3干砌石砌筑工程量:2×74.2×0.3+36×2×0.3×0.5= 55.3m3反滤料找平补齐工程量:2×74.2×0.25+36×2×0.25×0.5=46.1m34、上游马道平台以上(0+020-0+229.6)工程量为(如下图):干砌石拆除工程量:(12.1×36+10.5×32.4+12.1×122.6+12.4×18.6)×0.3= 746.97m3干砌石工程量:(12.1×36+10.5×32.4+12.1×122.6+12.4×18.6)×0.3= 746.97m3反滤料找平补齐工程量:(12.1×36+10.5×32.4+12.1×122.6+12.4×18.6)×0.25= 622.5m35、新建连接坡道与坝顶三角形夹角处(0+153.9-0+193.5)长39.6米(如下图)。

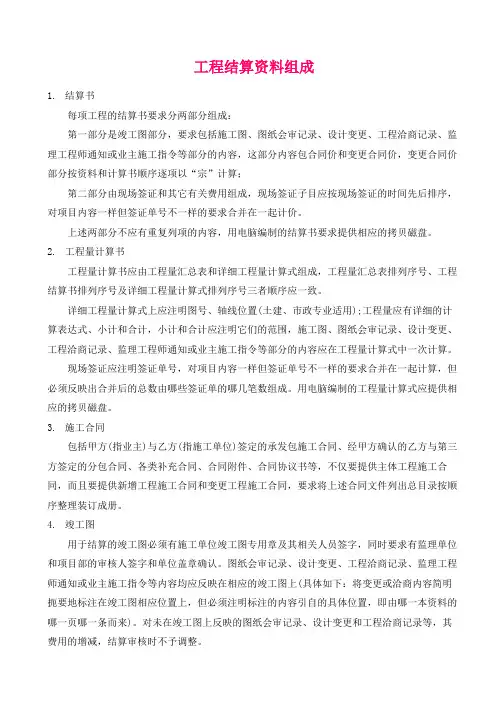

工程结算资料组成1.结算书每项工程的结算书要求分两部分组成:第一部分是竣工图部分,要求包括施工图、图纸会审记录、设计变更、工程洽商记录、监理工程师通知或业主施工指令等部分的内容,这部分内容包合同价和变更合同价,变更合同价部分按资料和计算书顺序逐项以“宗”计算;第二部分由现场签证和其它有关费用组成,现场签证子目应按现场签证的时间先后排序,对项目内容一样但签证单号不一样的要求合并在一起计价。
上述两部分不应有重复列项的内容,用电脑编制的结算书要求提供相应的拷贝磁盘。
2.工程量计算书工程量计算书应由工程量汇总表和详细工程量计算式组成,工程量汇总表排列序号、工程结算书排列序号及详细工程量计算式排列序号三者顺序应一致。
详细工程量计算式上应注明图号、轴线位置(土建、市政专业适用);工程量应有详细的计算表达式、小计和合计,小计和合计应注明它们的范围,施工图、图纸会审记录、设计变更、工程洽商记录、监理工程师通知或业主施工指令等部分的内容应在工程量计算式中一次计算。
现场签证应注明签证单号,对项目内容一样但签证单号不一样的要求合并在一起计算,但必须反映出合并后的总数由哪些签证单的哪几笔数组成。
用电脑编制的工程量计算式应提供相应的拷贝磁盘。
3.施工合同包括甲方(指业主)与乙方(指施工单位)签定的承发包施工合同、经甲方确认的乙方与第三方签定的分包合同、各类补充合同、合同附件、合同协议书等,不仅要提供主体工程施工合同,而且要提供新增工程施工合同和变更工程施工合同,要求将上述合同文件列出总目录按顺序整理装订成册。
4.竣工图用于结算的竣工图必须有施工单位竣工图专用章及其相关人员签字,同时要求有监理单位和项目部的审核人签字和单位盖章确认。
图纸会审记录、设计变更、工程洽商记录、监理工程师通知或业主施工指令等内容均应反映在相应的竣工图上(具体如下:将变更或洽商内容简明扼要地标注在竣工图相应位置上,但必须注明标注的内容引自的具体位置,即由哪一本资料的哪一页哪一条而来)。
工程量计算书范本工程量计算书范本项目名称:XX工程项目项目地点:XX市XX区XX街XX号一、工程概况本项目为XX工程项目,位于XX市XX区XX街XX号,总建筑面积为XX平方米,主要包括建筑物及相关附属设施的建设。
二、工作内容本工程的主要工作内容包括但不限于:1. 地基与基础工程:包括地面平整、土方开挖、回填、基础沉降、基础深度等计算;2. 结构工程:包括混凝土结构、钢结构、木结构等的计算,包括造价计算;3. 功能分区工程:包括墙体、门窗、地面、天花板、楼梯等的计算;4. 建筑安装工程:包括电气安装、水暖安装、通风与空调、消防安装等的计算;5. 其他附属设施工程:包括园林绿化、道路与管道等的计算。
三、计算方法1. 根据设计图纸及相关规范,采用相应的计算公式和方法进行计算;2. 结构工程的计算参考相关国家标准和规范,如《建筑结构荷载规范》、《钢结构设计规范》等;3. 安装工程的计算参考相关国家标准和规范,如《建筑给水排水设计规范》、《建筑电气设计规范》等;4. 人工工程采用按照人工工作量和工时进行计算,材料工程采用按照材料数量和材料单价进行计算。
四、计算结果经过细致的计算,得出本工程的计算结果如下:1. 地基与基础工程:由于地质条件良好,地基与基础工程总工程量为XX立方米;2. 结构工程:根据设计图纸,结构工程总工程量为XX平方米;3. 功能分区工程:功能分区工程总工程量为XX平方米;4. 建筑安装工程:建筑安装工程总工程量为XX平方米;5. 其他附属设施工程:其他附属设施工程总工程量为XX平方米。
五、工程造价根据计算结果及相关单价,可以得出本项目的工程造价如下:1. 地基与基础工程造价:地基与基础工程造价为XX万元;2. 结构工程造价:结构工程造价为XX万元;3. 功能分区工程造价:功能分区工程造价为XX万元;4. 建筑安装工程造价:建筑安装工程造价为XX万元;5. 其他附属设施工程造价:其他附属设施工程造价为XX万元。
水利工程量计算书一、土地平整工程1、挖掘机挖运土方(1-277)共231025 m32、推土机平整土方(1-219)共495075 m3二、道路工程1、田间道(18153米)(1)挖掘机挖运土方(1-277)(5.6+4)/20.418153*1.3=45309.888m3(2)路基土方压实(1-393)(5.6+4)/20.418153=34853.67m3(3)沙砾石层20cm厚(6-31H)418153=72612m22、生产路(43989米)(1)挖掘机挖运土方(1-277)(3.2+2)/20.3439891.3=44604.846m3(2)路基土方压实(1-393)(3.2+2)/20.343989=34311.42m3(3)砂砾石面层10cm厚(6-31H)243989=87978 m2三、水利工程1、灌水斗渠(9331米)(1)人工挖沟槽土方(1-12)1.18(0.75-0.15)9331=6606.35 m3(2)土方回填(1-371)1.18(0.75-0.15)9331=6606.35 m3(3)C20砼沟底垫层25cm (4-174)1.180.259331=2752.64 m3(4)M5.0水泥砂浆砌砖明渠(3-31)0.240.529331=2239.44 m3(5)M7.5水泥砂浆批挡2.5cm (3-78)[(0.25+0.24+0.5)2+0.7] 9331=25007.08 m2 2、灌水农渠(53334米)(1)人工挖沟槽土方(1-12)0.96(0.5-0.15)53334=17920.224 m3(2)土方回填(1-371)0.96(0.5-0.15)53334=17920.224 m3(3)C20砼沟底垫层20cm (4-174)0.960.253334=10240.128 m3(4)M5.0水泥砂浆砌砖明渠(3-31)(0.180.3)253334=5760.072m3(5)M7.5水泥砂浆批挡2.5cm (3-78)[(0.2+0.18+0.3)2+0.6]53334=104534.64 m23、排水斗沟(3413米)(1)人工挖沟槽土方(1-12)(1.3+1.1)(1.05-0.15)/23413=3686.04m3 (2)土方回填(1-371)(1.3+1.1)(1.05-0.15)/23413=3686.04m3 (3)M5.0水泥砂浆砌石明沟(3-40)(0.30.8)23413=1638.24 m3(4)C20 砼沟底垫层(1-90)34131.10.25=938.575m34、排水农沟(22946米)及蓄水池(1)人工挖沟槽土方(1-12)(1.1+0.9)(0.8-0.15)/222946=14914.9 m3 (2)土方回填(1-371)(1.1+0.9)(0.8-0.15)/222946=14914.9 m3 (3)M5.0水泥砂浆砌石明沟(3-31)0.30.6222946=8260。
