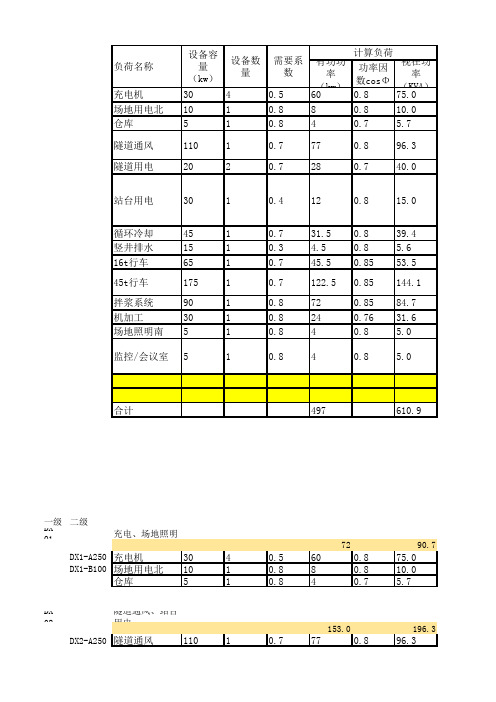

有功功率(kw)功率因数cos Φ视在功率(KVA)充电机3040.5600.875.0场地用电北1010.880.810.0仓库510.840.7 5.7隧道通风11010.7770.896.3隧道用电2020.7280.740.0站台用电3010.4120.815.0循环冷却4510.731.50.839.4竖井排水1510.3 4.50.8 5.616t行车6510.745.50.8553.545t行车17510.7122.50.85144.1拌浆系统9010.8720.8584.7机加工3010.8240.7631.6场地照明南510.840.8 5.0监控/会议室510.840.85.0合计497610.9一级二级DX-01充电、场地照明7290.7DX1-A250充电机3040.5600.875.0DX1-B100场地用电北1010.880.810.0仓库510.840.7 5.7DX-02隧道通风、站台用电153.0196.3DX2-A250隧道通风11010.7770.896.3DX2-B100隧道用电2020.7280.740.0负荷名称设备容量(kw)设备数量需要系数计算负荷DX2-C160站台用电3010.4120.815.0循环冷却4510.731.50.839.4竖井排水1510.3 4.50.8 5.63645.0DX-03168.0197.6 DX1-C16016t行车6510.745.50.8553.5DX1-D16045t行车17510.7122.50.85144.1DX-04拌浆、机加工、会议室、场地照明104126.2848 DX4-A1001拌浆系统9010.8720.8584.7DX4-B1001机加工3010.8240.7631.6DX4-B1002场地照明南510.840.8 5.0DX4-A1002监控/会议室510.840.8 5.0DX4-A1007689.7 DX4-B1002836.6A B252004405002520025403510016017035605020505030702017020070150铝5050铜90150变压器总功率计算盾构电缆3*70+3*35/E 变压器2000KVA170698.4988电缆长度(KM):1.5△Ue%=0.005=0.73874电缆平方长度1配电箱*4路*250A 70201配电箱*4路*250A1配电箱*4路*250A252003配电箱*4路*100A 铝50501配电箱*4路*160A1配电箱*4路*250A 1配电箱*4路*250A△ U%=△Ue%IL=0.07×191。
xx二期工程现有设备功率统计
xx二期工程自开工至今,施工用电一直处于非常紧张的状态,压桩机、灌注桩机及搅拌桩机同时进行作业,设备用电总功率远远大于总配电室的输出功率,尚不包括一期工程的施工用电。
根据总配电室的输出功率,只能满足以下设备的正常运行。
生活区用电 100Kw
灌注桩机 240Kw(80Kw/台,共3台)搅拌桩机 70Kw(70Kw/台,共1台)压桩机 150Kw(150Kw/台,共1台)泥浆泵 35Kw(35Kw/台,共1台)总计 595Kw
注:
此统计不包含灌注桩分包单位所使用的空压机、电焊机等小型设备。
为保证施工进度的正常进行,现场将投入搅拌桩机1台(70Kw/台),灌注桩机1 台(80KW/台),合计150KW,现需增加同等功率的发电机一台。
位置名称数量单个功率(KW)总功率(KW) 106011配液平台搅拌机4114412泵房泥浆泵2224410消防泵房消防泵215306制冷间冷水机组126.526.52生产车间搅拌机341298食堂操作间蒸车11212100食堂操作间热水器112128制冷间离心泵2 5.51113泵房空气压缩机1111120配酸区离心式耐腐泵2 5.511104锅炉房离心泵2 5.51164总经理办公室热水器17.57.57制冷间真空泵1 5.5 5.521配酸区盐酸泵1 5.5 5.522配酸区液下泵1 5.5 5.567会议室空调1 5.5 5.592餐厅空调1 5.5 5.5101食堂操作间电饼铛15544资料室空调14450化验室空调14461总经理办公室空调14486男六号空调144105厂区路灯150.25 3.7554化验室干燥箱1 2.5 2.53生产车间搅拌机2 1.1 2.2 19平台库房氟塑料自吸泵1 2.2 2.2 30站长室空调122 35副站长室空调122 40主任室空调122 58女一号空调122 62总经理办公室空调122 74男一号空调122 76男二号空调122 79男三号空调122 82男四号空调122 85男五号空调122 1生产车间照明灯120.1 1.2 9车间库房照明灯120.1 1.2 97食堂操作间消毒柜1 1.2 1.2 18平台库房移动式耐腐泵1 1.1 1.1 16平台库房照明灯100.11 51化验室水浴锅111 17配液平台照明灯80.10.8 27监控室空调10.740.74 47天平室空调10.740.74 60女二号空调10.740.74 93餐厅空调10.740.74 31站长室饮水机10.50.5 36副站长室饮水机10.50.5 68会议室饮水机10.50.5 96食堂操作间饮水机10.50.591餐厅照明灯80.0550.44 23维修间照明灯40.10.4 99食堂操作间冰箱10.3610.361 65会议室照明灯60.0550.33 63总经理办公室照明灯300.010.3 94餐厅吊扇40.060.24 24一排走廊照明灯40.0550.22 42资料室照明灯40.0550.22 69二排走廊照明灯40.0550.22 70三排走廊照明灯40.0550.22 87男六号照明灯40.0550.22 88四排走廊照明灯40.0550.22 95食堂操作间照明灯40.0550.22 32站长室电脑10.20.2 37副站长室电脑10.20.2 38副站长室打印机10.20.2 45资料室电脑10.20.2 46资料室打印机10.20.2 66会议室吊扇30.060.18 14泵房灯管40.040.16 43资料室吊扇20.060.12 25监控室照明灯20.0550.11 28站长室照明灯20.0550.11 33副站长室照明灯20.0550.11 39主任室照明灯20.0550.11 48天平室照明灯20.0550.11 49化验室照明灯40.0550.1156女卫生间照明灯20.0550.11 57女一号照明灯20.0550.11 59女二号照明灯20.0550.11 71男卫生间照明灯20.0550.11 72洗刷间照明灯20.0550.11 73男一号照明灯20.0550.11 75男二号照明灯20.0550.11 78男三号照明灯20.0550.11 81男四号照明灯20.0550.11 84男五号照明灯20.0550.11 89女浴室照明灯20.0550.11 90男浴室照明灯20.0550.11 102食堂储物间照明灯20.0550.11 4生产车间探照灯50.020.1 5车间配电室灯管20.040.08 15动力配电室灯管20.040.08 53化验室膨胀仪10.0660.066 26监控室吊扇10.060.06 29站长室吊扇10.060.06 34副站长室吊扇10.060.06 41主任室吊扇10.060.06 52化验室搅拌器10.060.06 77男二号吊扇10.060.06 80男三号吊扇10.060.06 83男四号吊扇10.060.06 103食堂储物间吊扇10.060.06 55化验室张力仪10.030.03107 108 109 110 111 112 113 114 115 116 117 118 119 120 121 122 123 124 125 126 127 128 129 130 131 132 133134 135 136 137 138 139 140 141 142 143 144 145 146 147 148 149 150 151 152 153 154 155 156 157 158 159 160161 162 163 164 165 166 167 168 169 170 171 172 173 174 175 176 177 178使用频率使用时间少22221515未使用未使用5.5 5.5少5.5 5.55.5 5.5未使用一般少2222未使用一般较多1较多111111111未使用71.5未使用一般少少少较多较多少少较多较多一般少少一般一般未使用未使用少少较多较多。
施工现场用电量分析规范3.1现场和办公区用电统计:3.1.1施工现场用电主要分为:施工生产加工机械、焊接设备、给排水泵、施工现场照明,办公和辅房用电。
3.1.2施工现场所用的小型电动工具忽略不计(其用电负荷在设计余量或现场用电不在满负荷使用情况下分流)3.1.3现场未设生活区,以下不计3.1.4主要用电计量统计表:表1 施工主要电动机械设备配备表2. 主体钢结构和机电及装饰用焊接设备表3. 施工现场所需照明灯具1)室外照明∑P 1cos φ序号 灯具名称 规格(KW)数量(盏)容量(KW)等效功率(KW)1 镝 灯 3.5 6 21 23.12 防爆小镝灯 0.4 4 1.6 1.76 3其他6 合 计30.863.1.5现场办公及辅房用量按15KW 计算。
3.2用电负荷计算采用需要系数法进行负荷计算,公式为SSH=1.05~1.1(K1 +K2∑P2+ K3∑P3+ K4∑P4)由公式求得施工现场设备用电量后,即为施工现场所需供电总容量,即Sz ≥SSH 式中:Sz ——施工现场供电站提供的总容量(500KV A ) SSH ——施工现场用电设备所需总容量(KV A ) ∑P1——施工现场用电动机额定功率之和(KW ) ∑P2——施工现场用电焊机额定功率之和(KW ) ∑P3——施工现场室外照明容量之和(KW )∑P4——施工现场用室内(办公区)用电容量之和(KW ) 1.05~1.10——容量损失系数η——电动机效率系数,平均为0.75~0.90,一般为0.85。
K1——电动机同时使用系数,10台以内取0.7,11~30台取0.6,30台以上取0.5。
K2——电焊机同时使用系数,3~10台取0.6,10台以上取0.5。
K3——电子电感式用电系数,5-10KW 以上取1。
K4——纯电子电路用电系数, 5KW 以上取0.6。
cos φ——电动机平均功率因数,施工现场最高取0.75~0.78,一般取0.65~0.75。

主要生产机械一览表2023.03以下是2023年3月3日的主要生产机械一览表。
以上机械是我们公司在2023年3月3日使用的主要生产机械。
每个机械都有各自特定的功能和生产能力,以满足我们的生产需求。
请注意,此表仅为范本,实际使用时应根据具体情况进行调整和填写。
以上是2023年3月3日的主要生产机械一览表。
以上机械是我们公司在2023年3月3日使用的主要生产机械。
每个机械都有各自特定的功能和生产能力,以满足我们的生产需求。
请注意,此表仅为范本,实际使用时应根据具体情况进行调整
和填写。
